West-East Gas Pipeline 3

From Global Energy Monitor
This article is part of the Global Fossil Infrastructure Tracker, a project of Global Energy Monitor.
Sub-articles:

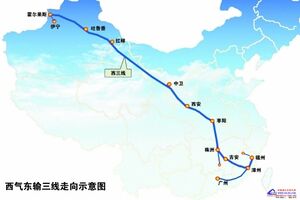

West-East Gas Pipeline 3 西气东输三线, also referred to as WEPP 3, is a natural gas pipeline with sections that are operating and in construction.[1]

Location

The pipeline runs from Khorgas (Horgos) in Xinjiang to Fuzhou in Fujian Province, China, crossing a total of ten provinces including Xinjiang, Gansu, Ningxia, Shaanxi, Hubei, Hunan, Jiangxi, Fujian, and Guangdong.[2]

Loading map...

Background

西气东输三线工程干线全线分为三段,西段(霍尔果斯-中卫)长2445km,设计压力12 MPa,管径1219mm,设计输气能力300×108m3/a;中段(中卫-枣阳-吉安)长2016km,设计压力12/10MPa,管径1219mm,设计输气能力300/250×108m3/a;东段(吉安-福州)长817km,设计压力10MPa,管径1219mm/1016mm,设计输气能力150×108m3/a。

The West-East Gas Pipeline 3 is being constructed in three sections: East, Middle, and West. The East and West Sections are currently operational, and construction on the Middle Section began in September 2021.

Construction of West-East Gas Pipeline 3 started in October 2012. The pipeline runs from Horgos in western Xinjiang to Fuzhou in Fujian.[3] It crosses Xinjiang, Gansu, Ningxia, Shaanxi, Henan, Hubei, Hunan, Jiangxi, Fujian, and Guangdong provinces.

The overall pipeline is composed of a west, middle, and east section, including eight major branches and some facilities like an LNG terminal, as well as three storage tanks. The pipeline was estimated to cost RMB 142.2 billion (about US$21.55 billion).

The west section was completed in August 2014[4] and runs the same route as the West-East Gas Pipeline 2. The east section that runs from Ji'an City in Jiangxi Province to Fuzhou City in Fujian Province was completed in December 2016.[5]

The pipeline has a capacity of 30 billion cubic meters per year of natural gas with operating pressure of 10–12 megapascal.[6] The pipeline is supplied from Central Asia–China Gas Pipeline's Line C, supplemented by supplies from the Tarim basin and coalbed methane in Xinjiang.[7]

In September 2021, construction began on the middle section.[8]

Project details

  • Capacity: 30 billion cubic meters per year[9]
  • Length: 7378 kilometers[10]
  • Cost: RMB 142.2 billion

West Section (Khorgos–Zhongwei) 西段 (霍尔果斯-中衛)

Loading map...
  • Owner: PetroChina West–East Gas Pipeline Company[9]
  • Parent company: China National Petroleum Corporation
  • Capacity: 30 billion cubic meters per year[9]
  • Length: 2445 kilometers[11]
  • Status: Operating[4]
  • Start year: 2014[4]

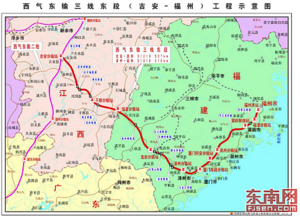

East Section (Ji'an–Fuzhou) 东段 (吉安-福州)

Loading map...
  • Operator: PetroChina West–East Gas Pipeline Company[9]
  • Parent company: China National Petroleum Corporation
  • Capacity: 30 billion cubic meters per year[9]
  • Length: 832.4 kilometers[9]
  • Status: Operating[9]
  • Start year: 2016[5][9][12]

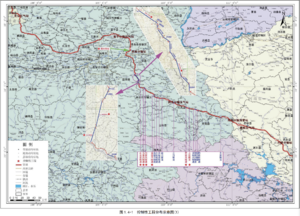

Middle Section (Zhongwei–Ji'an) 中段 (中卫-吉安)

Loading map...

Five branches were proposed on Middle Section. However, only two branches were completed and went operating. Zhuzhou-Chenzhou Branch, Dengzhou Branch and Xinye Branch were cancelled. [13]

变更后的西气东输三线中段(中卫-吉安)干线工程起自宁夏回族自治区中卫联络压气站(含),途经宁夏回族自治区中卫市、吴忠市、固原市,甘肃省庆阳市、平凉市,陕西省宝鸡市、咸阳市、渭南市、西安市、商洛市,河南省南阳市,湖北省襄阳市、随州市、荆门市、天门市、仙桃市、荆州市,湖南省岳阳市、长沙市、株洲市,江西省萍乡市、吉安市等7省(自治区)22市,止于江西省吉安联络站(不含)。工程全长2136公里(宁夏301.6公里、甘肃157.3公里、陕西515公里、河南232.1公里、湖北427.3公里、湖南335.8公里、江西166.9公里),设计管径1219毫米、压力10兆帕、输送能力250亿立方米/年。新建站场15座,与西气东输二线工程合建站场5座,新建监控阀室105座,依托现有5处维抢修机构,设置114处隧道弃渣场。采用沟埋敷设方式,埋深一般不小于1.2米。新建和改扩建施工便道311.52公里和221.6公里,新建和维修伴行道路21.23公里和24.09公里。

  • Owner: PetroChina West–East Gas Pipeline Company[9]
  • Parent company: China National Petroleum Corporation
  • Capacity: 25 billion cubic meters per year[14][15]
  • Length: 2136 kilometers[16][14]
  • Diameter: 1219 mm[17]
  • Status: Construction[8]
  • Start year:
  • Finance: 44700 million RMB[18]

Additional branches

The full Fujian–Guangdong Branch is proposed to be 595 kilometers in length, built in two phases.

Fujian–Guangdong Branch Phase I (Guangzhou–Chaozhou) 闽粤支干线 (广州-潮州)

The full Fujian–Guangdong Branch is proposed to be 595 kilometers in length, built in two phases.

This branch runs from Zengcheng, Guangzhou, Guangdong to Zhangzhou, Fujian province.[19] This first phase was commissioned in 2020 and included 388 kilometers of pipeline.[20]

Loading map...
  • Parent company: Chinese National Petroleum Company
  • Capacity: 5.8 billion cubic meters per year
  • Length: 385.88 kilometers
  • Status: Operating
  • Start year: 2020

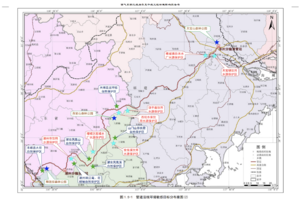

Fujian–Guangdong Branch Phase II (Chaozhou–Zhangzhou) 闽粤支干线 (潮州-漳州)

Loading map...
  • Parent company: Chinese National Petroleum Company
  • Capacity: 5.8 billion cubic meters per year
  • Length: 209.12 kilometers
  • Status: Proposed
  • Start year: 2020
This article is part of the Global Fossil Infrastructure Tracker, a project of Global Energy Monitor.
Sub-articles:

Zhongwei-Jingbian Branch Pipeline 中卫-靖边连接线[21]

The pipeline runs from Zhongwei, Ningxia to Jingbian, Gansu, China.

The pipeline's source is the West-East Gas Pipeline 3, the diameter is 1219 mm and the design pressure is 12 MPa.[21]

Loading map...
  • Operator: PetroChina
  • Parent Company: China National Petroleum Corporation
  • Current capacity: 30.0 bcm/year
  • Proposed capacity:
  • Length: 234.00 mi / 376.58 km
  • Diameter: 1219 milimeters
  • Status: Operating
  • Start Year: 2017

Changsha Branch 长沙支线 (安沙-望城)[22]

本项目西气东输三线长沙支线工程属于中段(中卫-吉安)中的一条支线,为实现长沙支线近期用气目标,就近从忠武线潜江-湘潭支线开孔接气,经0.448km连接线管道接引到现西三线中段干线安沙站站址处,再向长沙支线下游输气,经安沙镇、北山镇、桥驿镇、铜官街道、高塘岭街道到达望城末站。远期西三线中段干线建成后,正常接入西三线气源,经干线安沙站过滤调压后去往长沙支线分输支路,输送至望城末站。 主要建设内容包括连接线管道、长沙支线管道、2 座工艺站场(望城末站与长沙-益阳望城首站合建)和 2 座阀室。其中,连接线管道长0.448km、长沙支线管道长 45.652km,输气管道管径Φ508mm、设计输气规模为30×10 8 Nm3 /a、全线设计压力 6.3MPa;沿途有 G107、北山大道、S201、S102、武广高铁、京广铁路穿越等控制性工程。[22]

Loading map...
  • Owner: West To East Gas Transmission Branch of National Petroleum Pipeline Network Group Co., Ltd. 国家石油天然气管网集团有限公司西气东输分公司
  • Parent company: PipeChina
  • Capacity: 3 billion cubic meters per year
  • Length: 46 kilometers
  • Diameter: 508 milimeters
  • Status: Operating
  • Start year: 2019

Yining-Khorgas Branch 伊霍支干线(伊宁-霍尔果斯)[23]

Loading map...

伊宁—霍尔果斯输气管道工程于2011年5月12日开建,工程投资9.96亿元,线路全长约64公里,年输气量为300亿立方米,主要将伊犁河谷的煤制气通过该管道输送到西气东输三线。

  • Owner: China Petroleum West Pipeline Co., Ltd. 国家管网集团西部管道有限责任公司
  • Parent company: PipeChina
  • Capacity: 30 billion cubic meters per year
  • Length: 64 kilometers
  • Diameter: 1219 mm
  • Status: Operating
  • Start year: 2013

Xiantao-Qianjiang Connecting pipeline 仙桃-潜江联络线[24]

Loading map...

  • Owner: West To East Gas Transmission Branch of National Petroleum Pipeline Network Group Co., Ltd. 国家管网集团西部管道有限责任公司
  • Parent company: PipeChina
  • Capacity: 20 billion cubic meters per year
  • Length:21 kilometers
  • Diameter: 1219 milimeters
  • Status: Proposed
  • Start year:

Articles and resources

References

  1. West-East Gas Pipeline, Wikipedia, accessed March 2018
  2. West East Gas Pipeline III, Wood McKenzie, Nov. 1, 2017.
  3. "China Studying Third West-East Gas Pipeline - Report". Downstream Today. AFX News Limited. 2008-09-11. Retrieved 2008-12-25.
  4. 4.0 4.1 4.2 "西气东输三线西段全线贯通_要闻_新闻_中国政府网". www.gov.cn. Retrieved 2021-10-28.
  5. 5.0 5.1 "西气东输三线东段建成通气 福州形成双气源供应". Retrieved 2021-10-27.{{cite web}}: CS1 maint: url-status (link)
  6. West-East Gas Pipeline, Wikipedia, accessed March 2018
  7. Smith, Christopher E. (2012-10-23). "China starts construction on third West-East Gas Pipeline". Oil & Gas Journal. Pennwell Corporation. Retrieved 2012-10-24.
  8. 8.0 8.1 "中国电力新闻网". www.cpnn.com.cn. Retrieved 2021-10-28.
  9. 9.0 9.1 9.2 9.3 9.4 9.5 9.6 9.7 9.8 Third West-East Gas Pipeline fully completed, State-owned Assets Supervision and Administration Commission of the State Council, Dec. 14, 2018
  10. "West-East Gas Pipeline Project". Hydrocarbons Technology. Retrieved 2021-11-18.{{cite web}}: CS1 maint: url-status (link)
  11. "Supervision of the West Section (Khorgos-Zhongwei) Pipeline Project of the Third West-East Gas Pipeline". CNPC. Retrieved 2021-11-18.{{cite web}}: CS1 maint: url-status (link)
  12. "West-East Gas Pipeline Project Delivering Clean Energy and Facilitating Low-carbon Transition". CNPC. Retrieved 2021-11-18.{{cite web}}: CS1 maint: url-status (link)
  13. "关于西气东输三线中段(中卫-吉安)工程重大变动环境影响报告书的批复". www.mee.gov.cn. 2021-12-13.{{cite web}}: CS1 maint: url-status (link)
  14. 14.0 14.1 "【西气东输三线中段工程开工建设】-国家发展和改革委员会". www.ndrc.gov.cn. Retrieved 2021-11-18.
  15. "The middle section of the third West-East Gas Pipeline project started--Seetao". www.facebook.com. Retrieved 2021-11-18.
  16. "关于西气东输三线中段(中卫-吉安)工程重大变动环境影响报告书的批复". www.mee.gov.cn. 2021-12-13. Retrieved 2022-09-06.{{cite web}}: CS1 maint: url-status (link)
  17. 西气东输三线中段工程开工建设, 国家管网, 2021/09/29
  18. 中石油输气管道再开放 西气东输三线将引入民资,网易财经,2014/05/12
  19. 西气东输三线闽粤支干线工程环境影响报告书 Ministry of Ecology and Environment of China, August 2017.
  20. 西气东输三线闽粤支干线(广州—潮州段)投产 《南方日报》网络版. January 22,2020
  21. 21.0 21.1 Song Mintao He Zhidan 西气东输中靖联络线成功投产 保障京津冀等区域供气 China News Network/M.news.cn, Nov 28, 2017
  22. 22.0 22.1 "西气东输三线长沙支线工程竣工环境保护验收调查报告" (PDF). http://hraes.cn. 2020-04-22. {{cite web}}: External link in |website= (help)CS1 maint: url-status (link)
  23. "国家管网集团油气管网设施基础信息-国家能源局云南监管办公室". ynb.nea.gov.cn. 2022-06-22.{{cite web}}: CS1 maint: url-status (link)
  24. "省生态环境厅关于西气东输三线仙桃-潜江联络线工程环境影响报告书的批复-湖北省生态环境厅". sthjt.hubei.gov.cn. 2021-08-19.{{cite web}}: CS1 maint: url-status (link)

Related GEM.wiki articles

External resources

External articles

Wikipedia also has an article on West-East Gas Pipeline 3 (West-East Gas Pipeline). This article may use content from the Wikipedia article under the terms of the Creative Commons Attribution-ShareAlike 3.0 Unported License].
