Japan Offshore Wind Development

From Global Energy Monitor

Introduction

According to the Intended Nationally Determined Contributions (INDC) Japan submitted to UNFCCC in October 2021, the country aims to reduce its greenhouse gas emissions by 46% in the fiscal year 2030 from its fiscal year 2013 levels, which equals to reducing and removing 760 Million t-CO2 of Greenhouse gas emissions. Japan continues to set the goal of cutting its emission by 50% and be aligned with the long-term goal of achieving net zero by 2050.[1][2][3]

Japan is in the midst of its energy transition. While fossil fuel-based electricity supply has fallen by approximately 1.9% each year while renewable energy (wind, solar, hydropower) has increased annually for ten years straight. In that same period, carbon dioxide emissions have decreased by 22.5%.[4]

Current System Description

Current Power Capacity Mix

Japan's peak energy demand averaged 161,820 MW in FY2023 and is predicted to grow to 162,200 MW in FY2024. Nationwide demand peaks in summer months.[5] Operating capacity by generation type is summarized in the table below:[4]

Japan's Electricity Generation by Energy Type in 2022 (measured in terawatt-hours, TWh)

Bar chart depicting the electricity generation trends from various energy sources spanning from 2010 to 2022. In 2022, with the exception of oil, solar, and biomass, all other energy types experienced a decrease compared to 2021. Biomass energy exhibited the largest increase at 11.6%, followed by oil at 7.7% and solar at 7.6%.

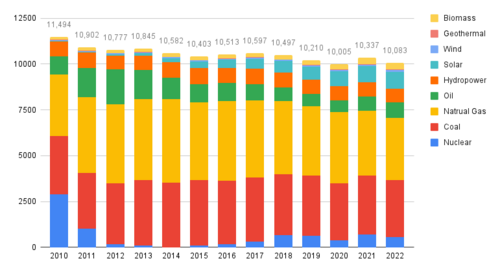

Electricity generation in Japan from 2010 through 2022. Data from the FY2022 Energy Supply and Demand Report.
Energy Source Generation (TWh)
Nuclear 561
Coal 3,106
Natural Gas 3,402
Oil 825
Hydropower 769
Solar 926
Wind 93
Geothermal 30
Biomass 371



Excitingly, Akita Port (Tohoku) offshore wind farm, the first commercial offshore wind farm with awarded FIT[6] in Japan, started operation in January 2023 under the FIT system.[7]

Prospective Power Capacity

The energy demand from the electricity sector in 2030 is expected to be over 350GW, and the add-up of solar and wind is expected to contain over one-third of the share.[8] Through 2032, approximately 27,448 MW of new generation capacity is expected to come online. Prospective power capacity is summarized in the table below:[5]

Generation type Capacity added by 2032 (MW) Total capacity in 2032 (MW)
Conventional hydropower 516 21,970
Coal 1,800 50,940
Liquefied natural gas 6,237 81,990
Oil and Others 30 17,670
Nuclear 10,180 33,080
Wind 3,515 17,800
Solar 3,773 97,070
Geothermal 75 550
Bioenergy 1,220 6,560
Waste 46 900
Battery Storage 55 230

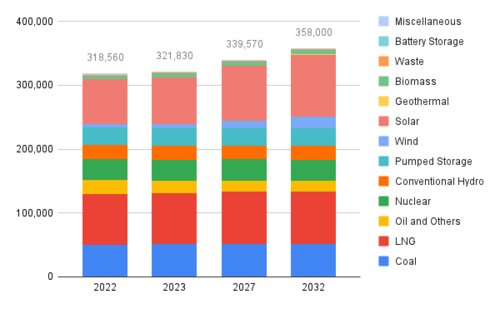

The data analysis in this chart covers the period from 2023 to 2032 and is based on electric supply plans published by the Cross-regional Coordination of Transmission Operators (OCCTO) in 2023. The total installed capacity is projected to increase from 318GW in 2022 to 358GW in 2032. During this timeframe, solar and wind energy are expected to see significant growth. Solar capacity is forecasted to rise from 70GW to 97GW, while wind capacity will more than triple from 5.3GW to 17.8GW. Fossil fuel sources, such as coal and LNG, are anticipated to experience slight increases. Oil and other sources are expected to decrease from 21.6GW to 17.67GW. Nuclear capacity will remain unchanged throughout the decade. There are no significant changes expected in conventional hydropower, pumped storage hydropower, or geothermal energy. These projections are based on data aggregated from submissions by Electric Power Companies (EPCOs), but actual outcomes may vary due to operational factors or changes in political policies.
Predicted installed capacities in Japan, 2022-2032. Data from the Organization for Cross-regional Coordination of Transmission Operators.

Renewable Targets

Offshore Wind Target:

Vision for Offshore Wind Power Industry(1st)December 15, 2020, Public-Private Council on Enhancement of Industrial Competitiveness for Offshore Wind Power Generation


The Vision for Offshore Wind Power Industry Report presented the 2030 and 2040 targets for nine prefectures. According to the report, the local 2030 targets are "based on projects that are undergoing environmental assessment"; the local 2040 targets are based on LCOE (Levelized Cost of Energy) and other data from the NEDO Report on the Support Project for the Development of Floating Wind Farms (Study of Offshore Wind Power Generation Costs), with reviews from experts and power producers. The potential of floating offshore wind in each prefecture was not included in the target capacity.[13]

  • 100GW by 2050GW: which will support one-third of Japan's energy supply by mid-century. Of that, 40 GW will be bottom-fixed offshore wind, and 60 GW will be floating offshore (and 40GW from onshore wind by 2050)[15]

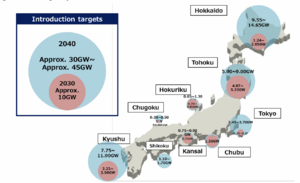

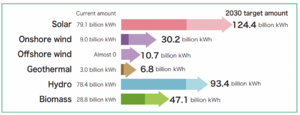

In the energy mix for 2030, the goal is to utilize renewable energy to contribute 330 to 350 billion kWh. JAPAN'S ENERGY, METI FEB 2023


The first floating offshore wind will be built at Goto City in Nagasaki Prefecture by a consortium of six companies led by Toda Corporation selected in June 2021[16]

Beyond these government targets, non-governmental organizations operating in Japan have outlined interim targets needed to reach long-term goals. For example, the Renewable Energy Institute argues that 20.5 GW of fixed bottom and 5 GW of floating offshore wind needs to come online by 2035,[17] whereas the Japan Wind Power Association claims that 40 GW of fixed bottom and 60 GW of floating is needed by 2050.[18]

Offshore Wind Potential

Asia: The Next Frontier for the Offshore Wind Industry. Asia Wind Energy Association, 2018

From the research in 2018, the prefectures with the highest offshore wind potentials are Hokkaido, Tohoku, and Shikoku. The potential capacity in Hokkaido, which is over 200GW, is higher than the add-up of the latter two regions.[19]

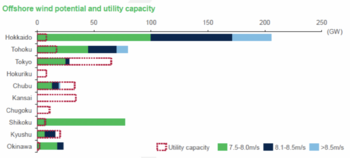

According to the official institution in Japan, NEDO, the potential of hard mount base offshore wind is 128 GW, and the floating offshore wind potential is 424GW in the country.[20] [21]

Major Renewable Projects

Operating Projects[22]

秋田県秋田港及び能代港における洋上風力発電プロジェクトの全面商業運転開始について, Marubeni 丸紅株式会社, Jan-31-2023,
Operating Projects Japanese Name Capacity Status

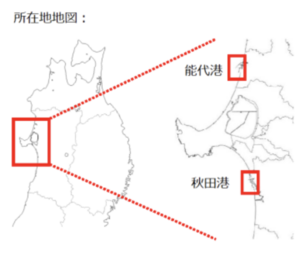

Akita Port (Tohoku) offshore wind farm(Another name:Akita Noshiro Offshore wind farm) 秋田洋上風力発電株式会社/秋田港と能代港洋上風力発電:[23]
  1. 秋田港洋上風力発電所 Akita Port (Marubeni) Offshore wind farm(54.6MW)
  2. 能代港洋上風力発電所 Noshiro City (Marubeni) Offshore wind farm(84MW)[24]
140MW Operating[7][25]
Kamis Offshore wind farm
  1. ウィンド・パワーかみす第1洋上風力発電所(14MW)
  2. ウィンド・パワーかみす第2洋上風力発電所(16MW)
30MW Operating
Sakata North Port (Nearshore) Offshore wind farm 酒田風力発電事業[26] 16MW Operating(Another 28MW in pre-construction stage)

Promoting & Promosing & Upcoming Areas

The developing area for Japanese offshore wind is divided into three categories: Promoting Area 促進区域, Promising Area 有望な区域, Upcoming Area 準備区域 depends on its progress of the investigation of potential capacity, stakeholders' negotiation, assessment, infrastructure, and natural and social conditions.[27]

The latest update by the Japanese government is on May 12th, 2023, and the designated areas are as the list below and the map:

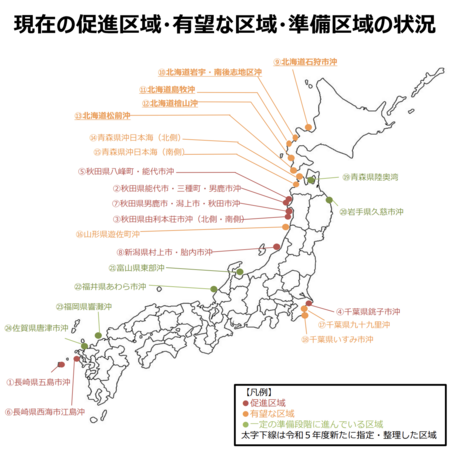

Promoting, promising, upcoming area of Japanese offshore wind 促進区域、有望な区域等の指定・整理状況, Natural Resources and Energy 経済産業省 資源エネルギー庁, Update in May 23, 2023


* Promoting Area 促進区域 * Auction Completed 事業者選定済

Area (Japanese) Project Capacity Details Status
①長崎県五島市沖(浮体) Goto City (Chubu Electric Power) Offshore Floating wind farm 17MW 2.1MW×8 Construction. Operate by 2024[28]
②秋田県能代市・三種町・男鹿市沖Noshiro-Mitane-Oga Offshore wind farm Noshiro City (C-TECH) Offshore wind farm[29] 479MW 12.6MW×38 Pre-construction. Operate by 2028[29]
③秋田県由利本荘市沖 Yurihonjo (Mitsubishi) Offshore wind farm[30] 819MW 12.6MW×65 Pre-construction. Operate by 2030[30]
④千葉県銚子市沖 Choshi Offshore wind farm[31] 391MW 12.6MW×31 Pre-construction. Operate by 2028[31]


* Promoting Area 促進区域 * Auction in progress 事業者公募中

  • ⑤秋田県八峰町能代市沖[34]

Happou Noshiro (JERA) offshore wind farm, Happou Noshiro (JRE) Offshore wind farm, Happou Noshiro (RWE) offshore wind farm, Happou Noshiro (TEPCO) Offshore wind farm, Happou Noshiro (Tohoku Electric Power) Offshore wind farm, Noshiro City (Mitsubishi) Offshore wind farm, Noshiro City (JRE) Offshore wind farm, [35][32]

Noshiro City (Mitsubishi) Offshore wind farm was in the process but canceled in December 2022[36]

  • ⑥長崎県西海市江島沖[37]

Saikai-Enoshima Offshore wind farm, West Offshore Wind Power Generation Project[37]

  • ⑦秋田県男鹿市・潟上市・秋田市沖

Katagami-Oga-Akita Offshore wind farm[38]

  • ⑧新潟県村上市・胎内市沖[39]

Tainai City, Niigata Prefecture And Murakami City Offshore wind farm, Niigata (Flotation Energy) offshore wind farm, Murakami City Tainai City Offshore wind farm, Niigata (Invenergy) offshore wind farm, Northern Niigata Offshore wind farm, Toki Floating wind farm[39]


* Promising Area 有望区域

  • ⑨北海道石狩市沖

Ishikari Bay - IBOWPG Offshore wind farm, Ishikari Bay (JERA) Offshore wind farm, Ishikari Bay (JRE) Offshore wind farm, Ishikari Bay (JWD) offshore wind farm, Ishikari Bay (OWF) offshore wind farm, Ishikari City Coastal offshore wind power project, Ishikari Bay (Nippon Steel) offshore wind farm, Ishikari Bay New Port offshore wind farm, Hokkaido Ishikari Bay Offshore wind farm [40]

  • ⑩北海道岩宇・ 南後志地区沖[41]
  • ⑪北海道島牧沖[41]
  • ⑫北海道檜山沖[41]
  • ⑬北海道松前沖[41]
  • ⑭青森県沖日本海(北側)

Aomori Offshore wind farm, Seihoku-Oki Offshore wind farm

  • ⑮青森県沖日本海(南側)

Aomori (South Side) Offshore wind farm, Tsugaru (RWE) Offshore wind farm, Tsugaru Ajigasawa offshore wind farm, Ajigasawa Offshore wind farm, Tsugaru (GPI) Offshore wind farm, Tsugaru (JERA) Offshore wind farm, Tsugaru (JWD) Offshore wind farm[42]

  • ⑯山形県遊佐町沖

Yamagata Prefecture Yuza Offshore wind farm, Yamagata Yuza Town Offshore Wind Power Project_Invenergy Wind Llc, Yuza (ITOCHU) offshore wind farm, Yuza (JWD) offshore wind farm, Yuzau Town (Marubeni) Offshore wind farm , Yuzau Town (TEPCO) Offshore wind farm[43]

  • ⑰千葉県九十九里沖[44]
  • ⑱千葉県いすみ市沖

Isumi City (Chiba) offshore wind power project, Isumi City (Green Power) offshore wind farm, Isumi City (RENOVA) offshore wind farm, Isumi City offshore wind power project[45]


* Upcoming Area 準備区域

  • ⑲青森県陸奥湾
  • ㉒福井県あわら沖

Fukui Offshore wind farm

  • ⑳岩手県久慈市沖(浮体)

Hirono Offshore wind farm[46]

  • ㉓福岡県響灘沖

Kitakyushu Hibikinada Offshore wind farm

  • ㉑富山県東部沖 (着床・浮体)
  • ㉔佐賀県唐津市沖

Karatsu City (KEPCO) offshore wind farm, Karatsu City (RENOVA) offshore wind farm, Karatsu Offshore wind farm, Saga Karatsu City (Iberdola Renewable Japan) Offshore wind farm, Saga Karatsu City (Vena Energy) Offshore wind farm[47]

Projects of Unclear bidding status

Japan Offshore Wind Prospective Projects[22]
Project Capacity Status
Aker offshore wind farm 800MW Announced
Satsuma Offshore wind farm 鹿児島薩摩洋上風力発電事業 600MW Announced[48]
Enshunada Offshore wind farm遠州灘洋上風力発電 500MW Pre-construction
Kagoshima Offshore wind farm 鹿児島県における洋上風力発電 1,500MW Announced
Kashima Port Offshore wind farm 鹿島港洋上風力発電事業 181MW Pre-construction
Sakura Offshore Floating wind farm千葉佐倉洋上風力 520MW Announced
Hiyama Area Offshore wind farm秋田県潟上市 722MW Announced
Fukushima Demo floating wind farm 30MW Pre-construction

All projects that are under the assessment process can be found on the official webpage of the Ministry of Economy, Trade, and Industry - Wind Power Projects List[49]

Fossil Resources and Retirement

There is no committed coal phase-out plan from the Japanese government, but the authority plans to retire 100 inefficient coal-fired generators by 2030, which is over two-thirds of the total coal-fired generators in the country.[50] In FY2023, the Government of Japan planned to decommission 100 MW of liquefied natural gas, 110 MW of oil, and 33 MW of coal capacity.[5]

In the 2050 long-term vision, the government plans to decarbonize thermal power by utilizing hydrogen, ammonia, and carbon capture utilization and storage,[51] which are considered to be controversial by the NGOs.[52]

In 2023, when the G7 summit was held in Sapporo, Japan, the proposal from Canada and the UK on "setting a 2030 date for completing the goal of an accelerated phase-out of domestic unabated coal power generation" was rejected by Japan, U.S., and EU.[53]

Employment

Current employment by sector

In 2021, the KIKO Network 気候ネットワーク in Japan estimated that there were 151,000 workers employed in fossil fuel and energy-intensive industrial sectors, of that, around 14,207 were working in fossil fuel power sector[54]

Prospective employment from renewable energy sector

Potential offshore wind workforce including C&I(commercial and industrial) and O&M(operations and maintenance): 985MW with 1118 technicians.[55]

JWPA(Japan Wind Power Association) estimated in 2023 that by 2050, there would be 355,000 jobs with 140GW in total to be created by the wind industry in Japan.[15] Of that, 100GW will be offshore wind capacity, and 40GW will be onshore wind.

IRENA's 2023 report highlights that according to input-output analysis, achieving a capacity of 7 GW by 2030 could generate 54,000 jobs, including 20,000 direct jobs and 34,000 indirect jobs during the construction phase. Additionally, around 4,560 jobs would be created for operation and maintenance (O&M) as the farms become operational. If the capacity reaches 36 GW by 2040, it has the potential to create 69,000 jobs, with 18,000 dedicated to O&M.[56]

Renewable Energy Institute estimates that offshore wind construction will require 30,000-60,000 jobs per year and will total to more than 1.4 million jobs by 2050. This would have an economic ripple effect of more than 34 trillion yen. A major challenge for Japan's offshore wind industry is the fact that demand for workers exceeds the number of individuals with the suitable training and skills.[57]

Land availability

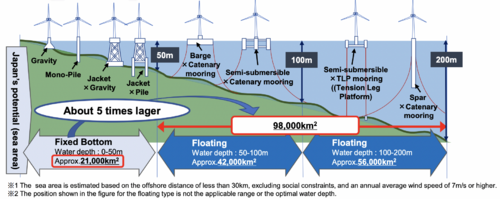

Offshore Wind Power Foundations type and Potential(Area) in Japan, NEDO, Nov-8-2022

According to NEDO(New Energy and Industrial Technology Development Organization), the biggest public research center on industry and technological innovation for energy, shows the potential ranges for different types of offshore winds from its research in 2022:[58]

  • Fixed Bottom Wind requires water depth from 0-50m, with approx.21,000km2 potential area in Japan

Gravity (2.4MW) NEDO Choshi (~2016), Jacket × Gravity (2MW) NEDO Kitakyusyu(~2016)

  • Floating Water Wind requires water depth from 50-100m, with approx.42,000km2 potential area in Japan

NEDO Project (Barge Type) Hibiki

  • Floating Water Wind requires water depth from 100-200m, with approx.56,000km2 potential area in Japan.

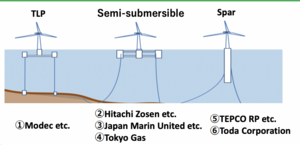

Semi-submersible (2MW), METI Fukushima(~2020), Spar(2MW), MOE Goto(~2015)

In 2023, the Japanese government is discussing expanding the wind farm locations from the inside territorial waters, which is 22km off the coast, to the exclusive economic zone (EEZ) which is 200 nautical miles, or about 370 km off the coast. The EEZ zone is estimated to be 45,000 km2 by the Asia Wind Energy Association and is the 8th largest EEZ area in the world.[19]

According to The Environment Ministry and others, the number of sites suitable for wind power generation with water depths of less than 200 meters will be three times greater than if they were limited to within 30 km of the coast.[59]. This discussion would be crucial for the development of Japan because the geological condition is less suitable for mounting wind farms in near seabeds compared to the conditions in other countries. Expanding wind farm locations would also expand the potential for floating wind farms. From experiences in other countries, seabed in the territorial waters area belongs to the national property, whereas EEZ lacks a legal framework and requires more coordinating efforts with fishermen and shipping companies[59].

Environmental and Social Impacts

Overview of current fossil fuel impacts

Japan does not own coal resources domestically, almost all of its coal resources are imported from coal mines in Australia and Indonesia.[60]

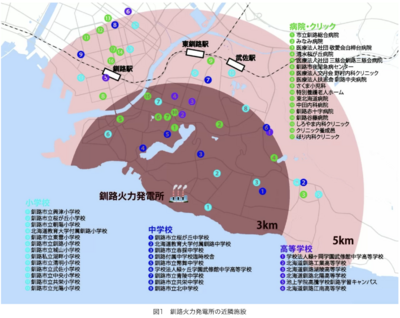

Health Impact on Local Residents in Kushiro, No Coal Kushiro釧路火力発電所を考える会

There are several alliances organized by local citizens to keep tracking the impact of coal-fired power plants. One of these groups, No Coal Kushiro, aims to stop the projective coal-fired power plant Kushiro power station located in Kushiro City, Hokkaido. According to their website, "The scale of the project is 112,000 kW, which is slightly below the 112,500 kW required for the national environmental assessment procedure, and construction has been started without conducting the national environmental assessment." The construction was delayed but shortly resumed and started operating in December 2020. From the map the No Coal Kushiro provided on their website, many schools, hospitals, and clinics are within 5 km of the Kushiro power station, increasing the health risks coal-fired pollution caused to children and the elderly to various diseases.[61]

Unlike the majority of the coal-fired plants in Japan which import coal overseas, the Kushiro power station claims the operation can boost the local economy because it tries to revive a once-retired small-scale mine in the city and can "produce and consume by the locals (地産地消)" According to the No Coal Kushiro, "A large amount of tax money was spent to revive the coal mine that was once closed, restart the coal mining business, generate power using the coal that was dug out from there as fuel, and sell the generated electricity."

Also, the campaign points out that the "produce and consume by the locals (地産地消) has a high chance to be false because "In 2002, Taiheiyo Coal Mine closed and Kushiro Coal Mine Co., Ltd. (KCM) took over the coal mining business. However, the coal mining volume, which used to be 5 million tons per year, dropped to 700,000 tons when KCM took over and has since declined further. Due to the decrease in the amount of coal mined by KCM, the train carrying coal was discontinued in June 2019. All the coal on the land side has already been dug up, and there is almost no coal left on the seabed. There is a high possibility that the business of “local production for local consumption” will not be viable."[61]

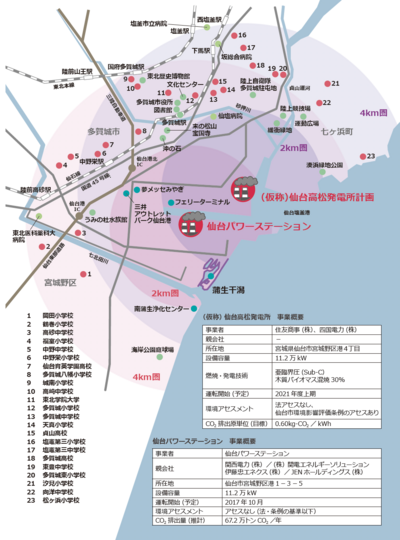

Impacts on the local community, sendai sekitan 仙台港の石炭火力発電所建設問題を考える会, 2018

Another local campaign happened in Sendai, Tohoku Region in the northeast of Tokyo. From the map below, the Sendai Takamatsu power station 仙台高松発電所 is canceled already. The company announced on April 10, 2018, that it would withdraw from the project. Also, on June 1st, Sumitomo Corporation announced that it would change its plan to biomass-only combustion.

When the Sendai power station 仙台パワーステーション was proposed, it was not subject to an environmental assessment under the Sendai City ordinance because the capacity is under the threshold, and no assessment was conducted.(now all coal-fired power plant plans in Sendai City are subject to environmental assessments.) The project is only 1km away from the Gamo Tidal Flat 蒲生干潟, a wetland and sandy beach ecosystem that provide food and habitats for migratory birds and benthic animals.[62] No clear data is released by the coal-fired company of the impacts on the wetland.[63]

The Sendai power station started operating in 2017.[63]

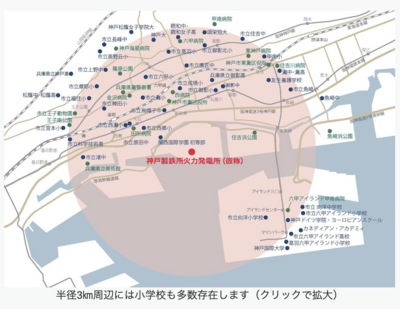

3km radius of elementary schools' region in Kobe City, kobe sekitan, 神戸の石炭火力発電を考える会

The ongoing lawsuit against the Kobe power station 神戸発電所 is located within the 3km radius region of many elementary schools and causing rising risks to the pupils' health. The Kobe local groups also argue that in Kansai, summer peak demand decreased by about 15% compared to before the March 11 2011 Japan Earthquake due to the energy saving initiatives from the citizens and businesses, and the trend of energy consumption in the region is expected to continue to decline. It is doubtful about the role of this coal-fired power plant.[64]

Potential impacts from renewable expansion

In 2011, the EIA process in Japan started to include wind projects over 10MW, and the regulations came officially into effect in 2012. The minimum years to go through the EIA process is three years.[19]

The Japanese government is working with local prefectures including Hokkaido(projects: Gann-u and Minami-Shiribeshi), Yamagata(projects: Sakata), Iwate(projects: Hirono-cho) on wind resource measurements, seabed surveys, environmental impact assessments, and local community surveys. These measurements will be finished by 2025 and ready for the auction round.[20]

The Vision states laws and acts that are accountable for screening and supervising the potential environmental and social impacts from offshore wind facilities:[13]

  • The offshore wind facilities in Japan should be inspected under Electricity Business Act, the Port and Harbor Act, the Ship Safety Act, Environmental Impact Assessment Act, and Building Standards Law.


Some restrictions and requirements awaited to be formulated are also stated in the document[13]. It asked to clarify the criteria for determining when to suspend work during strong winds in offshore wind power crane operations and relax conditions that prohibit mobile cranes from traveling with suspended loads, and clarify the criteria for granting permission to leave in place fixed-bottom wind turbines, for which sea areas are in principle required to be restored to their original state once wind turbines are removed based on Law Relating to the Prevention of Marine Pollution and Maritime Disaster.[13]

In 2021, the wind projects at Akita and Noshiro ports aroused concerns over the possible impacts on the local fisheries.[65]

In 2022, local fisher's groups worry that if Isumi City is designated as a "Promising Area", it will increase the risk of losing fish habitats due to changes in seafloor foundation work of offshore wind construction.[66]

Civil Engagement

The network of coal phased-out campaigns in Japan is nationwide. The Japan Beyond Coal[67] campaign aims for retiring all coal resources in Japan by 2030.

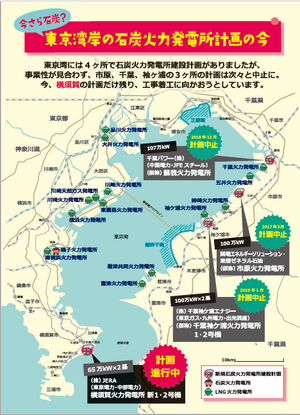

Coal-fired plants in Tokyo Bay: Cancelled and Ongoing Projects, 石炭火力を考える東京湾の会

There are also matured local networks for protesting against coal-related facilities in different prefectures. No Coal Tokyo Bay 石炭火力を考える東京湾の会, an alliance organized by local citizens and four NGOs including Kiko Network, FoE Japan, Greenpeace Japan、patagonia-international パタゴニア日本支社, shows that several coal-fired power plants' constructions have been stopped by the local protest. These projects are located in Ichihara City 市原市(stopped in March 2017)、Chiba City 千葉市(stopped in Dec 2018), Sodegaura 袖ケ浦市(stopped in Jan 2019).[68] Currently the local citizen is working on stopping the unit 1 and 2 coal-fired generators in Yokosuka 横須賀[68]

Another No Coal campaign organized by the local citizen is called No Coal Kushiro, monitoring the Kushiro power station which has operated since 2020.

Sendai No Coal campaign against the Sendai power station is the first lawsuit against a coal-fired company in Japan since the project did not undergo environmental assessment due to the insufficient ordinance of the Sandia City government. On September 27, 2017, 124 Miyagi residents, including local residents, filed a lawsuit against Sendai Power Station Co., Ltd.[63]

The Kobe Nop Coal Campaign is ongoing with the lawsuit against the construction unit of Kobe power station 神戸発電所. The Global Energy Monitor gathered information on the history and the lawsuits process on page Kobe power station

The Matsushima power station 松島発電所 with two units in operation and one unit under the pre-permit stage, is also the main site of the GENESIS Matsushima Project (GENESIS松島計画). The Act Matsushima (Act松島) campaign page shows more details about the civil initiatives.[69]

Symbolic Importance

  • Unlike Europe and other countries, the geological conditions are challenging for Japan to develop a large amount of bottom-fixed mounting wind farms. This is mainly because there are few shallow seas around Japan suitable for mounting turbines[59]. The potential of floating wind is three times larger than the bottom-fixed type. If the innovation progress, investment, and supply chain come into place, Japan can explore large-scale floating wind farms with less impact on the marine system. Therefore, floating offshore wind farms should be the majority of the country's wind energy.

Governmental information

Related government papers

  • Act on Promoting the Utilization of Sea Areas for the Development of Marine Renewable Energy Power Generation Facilities(Act No. 89) 海洋再生可能エネルギー発電設備の整備に係る海域の利用の促進に関する法律 was published in 2018.[70] It established a framework for carrying out these measures, including public tenders to select entities to conduct offshore wind power projects in four promotion zones and the establishment of a council for regional coordination.[13] It also allows general sea areas to "not administered under specific laws or regulations to be put to exclusive use for a maximum of 30 years.[65]"
  • Port and Harbor Act (Act No. 218 of 1950) 港湾法: Established in 1950 and more recently updated in 2018, the Act outlines regulation for developing and managing Japan's port infrastructure and waterway maintenance.[71]
  • Vision for Offshore Wind Power Industry 洋上風力産業ビジョン was published in 2020 by the Public-Private Council on Enhancement of Industrial Competitiveness for Offshore Wind Power Generation(洋上風力の産業競争力強化に向けた官民協議会[13]
  • 6th Strategic Energy Plan 第6次エネルギー基本計画 was published in 2021[72][73] [74]
  • Green Growth Strategy Through Achieving Carbon Neutrality in 2050 2050年カーボンニュートラルに伴うグリーン成長戦略を策定しました was published in 2021, with offshore wind targets stated in the document.[75][76]


The Japanese government aims to establish a central bidding system for offshore wind projects. The central government first worked with local prefectures including Hokkaido(projects: Gann-u and Minami-Shiribeshi), Yamagata(projects: Sakata), Iwate(projects: Hirono-cho) on testing an auction process.[20] After the auction in 2021, The Japanese government and the Public-Private Council(洋上風力の産業競争力強化に向けた官民協議会[77]) are working on improving information disclosure, two-stage developer selection, more reasonable price, and non-price point allocation and early introduction of the centralized auction system.[20]

Relevant political coalitions

  • Japanese Ministry of Land, Infrastructure, Transport and Tourism (MLIT)[20] - for seabed-right leasing, holding Public-Private Council on Enhancement of Industrial Competitiveness for Offshore Wind Power Generation(洋上風力の産業競争力強化に向けた官民協議会)[77] with METI.
  • Japanese Ministry of Economy, Trade and Industry (METI)[75][11] - for setting capacity targets, auction process, and technological development.
  • on Analysis of potential for and challenges in mid- to long-term introduction of offshore wind power generation;
  • The Public-Private Council on Enhancement of Industrial Competitiveness for Offshore Wind Power Generation(洋上風力の産業競争力強化に向けた官民協議会) held by MLIT and METI to analyze field-based challenges such as manufacturing and installing turbines, marine civil engineering, maintenance work, etc.); setting approaches for developing infrastructure and environments for systematic introduction (Power system integration, harbors/industrial complexes, etc.); and involving investments by companies (related industries), cost reduction, etc.[78]


Private sector:

  • Nippon Export and Investment Insurance (NEXI): investing overseas offshore wind farms[79]
  • Japan Wind Power Association (JWPA) 日本風力発電協会: Aims to expand wind generation in Japan by convening relevant private sector stakeholders which, in turn, will improve energy security and fight climate change.[80]
  • Renewable Energy Association for Sustainable Power Supply (REASP) 般社団法人再生可能エネルギー長期安定電源推進協会: Promote renewable energy throughout Japan with a specific focus on reducing burden on ratepayers while reducing reliance on feed-in tariff financing.[81]
  • Japan’s Floating Offshore Wind Group 浮体式洋上風力発電推進懇談会: Launched by Equinor, JGC Japan, Ocean Winds, Shell, Sumitomo Corporation, and Toda Corporation, the Group aims to promote floating wind technology as a mature and tested foundation suitable for Japan's offshore wind future.[82]

FIT and Tender Process

Auctions of offshore wind started in 2019 under the law on Promoting the Utilization of Sea Areas for the Development of Marine Renewable Energy Power Generation Facilities, which came to effect in the same year. Bids are evaluated both on cost, with the lowest tender price receiveing highest scores, and project feasibility, which encapsulates business and stakeholder engagement planning.[83]

Round 1 Competitive FIT Auction selected three areas:[65][11][16][6]

  • Noshiro City・Mitane Town・Oga City, Akita Prefecture. Support revenue from FIT (13,260 ¥en/MWh). Operate by 2028
  • Yurihonjo City(North・South), Akita Prefecture. Support revenue from FIT (11,990 ¥en/MWh). Operate by 2030
  • Choshi City, Chiba Prefecture. Support revenue from FIT (16,490 ¥en/MWh). Operate by 2028


Round 2 auctions aim to install approximately 1.8 GW of capacity: 700 MW off Niigata, 692 MW off Akita, and 424 MW of Nagasaki.[84] The second round of the auction in March for a wind farm offshore Happo-Noshiro, Akita Prefecture was suspended in March 2022,[16] though in March 2024, the results announced that a consortium of Japan Renewable Energy, Iberdrola Renewables Japan, and Tohoku Electric Power had won the auction. Round 3 is in-process (as of April 2024) with winners expected to be announced in December 2024.[85]

Offshore wind call areas are identified through a three-stage selection process: 1) central government works with prefectural governments to identify "potential areas" for development; 2) "potential areas" are assessed and upgraded to "promising areas" and evaluated by a third-party committee; and 3) "promising areas" are upgraded to "promotion areas" that are then auctioned off via tender.[86] Unlike previous tender processes, the government of Japan now leads studies confirming grid connection capability, which was previously led by project developers. The new study process is called a "grid security scheme" and is intended to accelerate offshore wind development.[87]

Transmission

Current transmission resources

Most of the country only has a unified frequency for its electricity transmission. However, West Japan and East Japan are using different frequencies[88]. This is because during the Meiji era, when the electric power industry spread, Tokyo imported a German-made 50Hz generator, while Osaka imported an American-made 60Hz generator. There have been discussions on whether or not domestic frequencies should be unified, but due to the enormous cost and time required, they have not been unified to this day.[89]

Japan is a country with frequent natural disasters such as earthquakes and typhoons. Black-outs events like the Hokkaido Eastern Iburi Earthquake in 2018 and the power shortage in the Tokyo metropolitan area in March 2022. In order to prevent large-scale black-out to happen again, power interchange through inter-regional interconnection is necessary. As a result, existing power transmission and distribution networks face issues such as differences in domestic frequencies and insufficient capacity of interconnection lines between regions. However, many of the steel towers and utility poles that make up the transmission and distribution network were built during the period of high economic growth in the 1970s, and are now aging. Many power transmission and distribution facilities have already been installed for more than 50 years, and large-scale equipment renewal of the national and regional grid is essential.[89]

The government announced the Next Generation of the energy network plan, strengthening the power grid, its flexibility, and transparency on the information for related service stakeholders.[90]

as of October 2023, Japan has 29 Specified Transmission, Distribution and Retail Companies; seven Specified Transmission and Distribution Companies, three Transmission Companies, and 10 General Transmission and Distribution Companies.[5]

New transmission needed for renewables

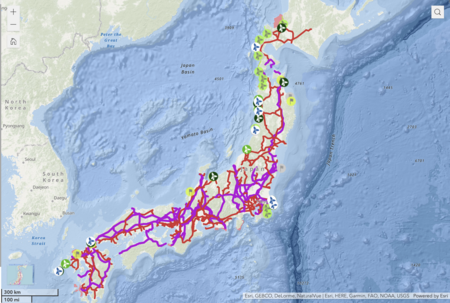

japan electricity transmission lines & offshore wind sites, osw project areas & transmission lines (beta version), 自然エネルギー財団

The Renewable Energy Institute 自然エネルギー財団 published the map of all current electricity transmission resources with operating and projective offshore wind sites, OSW Project Areas & Transmission Lines (beta version), [91]

In the Vision for Offshore Wind Power Industry, it stated the initiatives needed to be taken by the Japanese government on relevant infrastructure. The key actions on power grid-related initiatives are:[13]

  • Detail out and announce the first draft of the Power Grid Establishment Master Plan, which will contribute to the realization of introduction targets, by the coming spring.[13]
  • To harness the potential of offshore wind power, it is important to have a large power transmission network to bring power from suitable locations for offshore wind power generation to high-demand areas. To achieve this end, it is important to commence a concrete study of the introduction of HVDC power transmission, including technical issues and costs.[13]


Furthermore, the Organization for Cross-regional Coordination of Transmission Operators, JAPAN (OCCTO) 電力広域的運営推進機関 developed a plan to upgrade the national grid by 2050 in order to adjust the 50% renewable energy in the national mix. The amount is expected to be 6 to 7 trillion Japanese yen by the mid-century. Besides, there is a new power grid project to connect Hokkaido and Tohoku for its increasing solar and wind power generation other than this budget.[88]

Social and environmental impacts of new transmission

The Japanese government started to discuss expanding wind farms from inside territorial waters to the EEZ because of the limited potential capacity in the near seabed areas for mounting wind farms. Building transmission lines from EEZ to the land would raise the cost of electricity price.[59]

The regions with the richest potential for offshore wind, Hokkaido and Tohoku, are not matching with the high energy demand areas. The power demands from these two regions are only half of the demand in Tokyo[19]

Another issue is the insufficient transmission line capacity that required coordination with fishermen. Ishikari City, Hokkaido (石狩市,北海道) plans to resolve issues such as coordination with fishermen as soon as possible and aim to upgrade the area to a "promising area" in fiscal 2023.[92]

Ownership

Major owners of current fossil capacity

Coal-fired Power Plant Owner's List[93]

The top five leading entities in terms of operating coal power capacity in Japan collectively account for over 50% of the total operating capacity within the country. Among these companies, J-POWER 電源開発株式会社 and JERA Co. Inc 株式会社JERA are the primary owners of the coal power with over one-third of the national total.

The distribution of capacity among these companies is provided below, with the percentage of the national total operating capacity:

  • J-POWER 電源開発株式会社: 8,412MW (15.26%)
  • JERA Co. Inc 株式会社JERA: 9,670MW (17.54%)
  • Tohoku Electric Power Co Inc 東北電力株式会社: 3,800MW (6.89%)
  • Kyushu Electric Power Co Inc 九州電力株式会社: 3,460MW (6.28%)
  • Chugoku Electric Power Co 中国電力株式会社: 3,175MW (5.76%)


Gas-fired Power Plant Owners' List[94]

The top five leading entities in terms of operating gas power capacity in Japan collectively account for over 80% of the total operating capacity within the country.

Among these owners, JERA Co. Inc 株式会社JERA is the primary owner with 56.25% operating gas-fired capacity in Japan. The distribution of capacity among these companies is provided below, with the percentage of the national total operating capacity:

  • JERA Co. Inc 株式会社JERA: 43,691MW (56.25%)
  • Kansai Electric Power Co (KEPCO) 関西電力株式会社: 8,161MW (10.51%)
  • Tohoku Electric Power Co Inc 東北電力株式会社: 5,733MW (7.38%)
  • Kyushu Electric Power Co Inc 九州電力株式会社: 4,655MW (5.99%)
  • Chugoku Electric Power Co 中国電力株式会社: 2,543MW (3.27%)

Major owners of prospective offshore wind

The list below shows the major offshore wind companies with at least a total capacity of 1GW of operating or in-development projects in the pipeline.[22] It is worth noticing that the company Japan Renewable Energy CORP (JRE) ジャパン・リニューアブル・エナジ was purchased by Eneos Holdings, which is Japan’s biggest oil refiner.[20][95][22]

  • Cosmo Eco Power CO LTD: 1,050 MW (600 MW is co-owned by Iberdrola Renewables, and 450 MW is co-owned by Kato Sogyo Construction)
  • Flotation Energy PLC: 1,520 MW
  • Copenhagen Infrastructure Partners and Mitsubishi Heavy Industries 三菱重工業株式会社: 1,000 MW
  • Marubeni CORP 丸紅株式会社: 1,279 MW (279 MW co-owned by Obayashi; Tohoku Electric Power; Cosmo Eco Power; Kansai Electric Power (KEPCO); Chubu Electric Power; Akita Bank; Ohmori; Sawakigumi; Kyowa Oil; Kato Kensetsu; Kanpu; and Sankyo)
  • Mitsubishi CORP: 1,301 MW (391 MW co-owned by Chubu Electric Power, and 910 MW co-owned by Venti Japan and C-Tech)
  • WPD AG: 1,000MW

Supply Chain

Japan currently lacks a manufacturing industry for offshore wind development and relies on overseas imports.[13] The government has announced an investment plan for the supply chain. The supply chain will be invested with an overall under two development phases.[11] Phase one is the Developing component technology stage, and phase two is the testing and demonstration stage. The two phases are integrated into the plan of the Green Innovation Fund.

Under phase one development, the supply chain of offshore wind in Japan aims to reduce costs by using substitutes for steel materials (concrete floats, synthetic fiber mooring), to produce wind turbines that are suitable for natural conditions such as typhoons, earthquakes, lightning, strikes, and low wind speeds in Japan and Asia, to improve the durability of the cables that move along with the floating structures, and to predict failure rate using AI and big data. In phase two, the industry will integrally design and demonstrate an entire system that combines wind turbines, floating structures, and cables and verify the cost reductions.[96]

The following sections list the companies involved in the offshore wind supply chain on technological advancement.

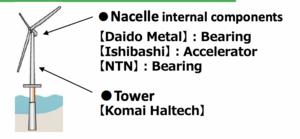

Wind Turbine Technology[11]

Supply Chain of Wind Turbine Technology. sourced from Keisuke MUTO, Introduction of Japan’s Offshore Wind Policy, Energy Efficiency and Renewable Energy Dept., Agency for Natural Resources and Energy, METI., July 2022

Nacelle internal components:

  • Bearing: Daido Metal 大同メタル工業株式会社, NTN Corporation
  • Accelerator: Ishibashi Manufacturing Co., Ltd. 株式会社 石橋製作所


Tower:

  • Komai Haltech 株式会社 駒井ハルテック

Manufacturing and Installing Floating Foundations[11]

Supply Chain of Manufacturing and Installing Technology in Offshore Wind Industry Technology. sourced from Keisuke MUTO, Introduction of Japan’s Offshore Wind Policy, Energy Efficiency and Renewable Energy Dept., Agency for Natural Resources and Energy, METI., July 2022
  • TLP(Tension Leg Platform): Modec 三井海洋開発, etc.
  • Semi-submersible: Hitachi Zosen 日立造船株式会社, Japan Marin United ジャパン マリンユナイテッド株式会社, Tokyo Gas 東京ガス, etc.
  • Spar: TEPCO RP 東京電力 リニューアブルパワー, Toda Corporation 戸田建設株式会社, etc.

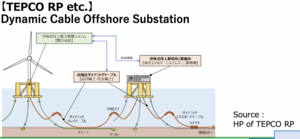

Dynamic Cable Offshore Substation[11]

Supply Chain of Dynamic Cable Offshore Substation in Offshore Wind Industry Technology. sourced from Keisuke MUTO, Introduction of Japan’s Offshore Wind Policy, Energy Efficiency and Renewable Energy Dept., Agency for Natural Resources and Energy, METI., July 2022

TEPCO RP 東京電力 リニューアブルパワー etc.

Operation and Maintenance[11]

  • Drone Inspection: Kansai Electric Power 関西電力株式会社 etc.
  • Cable Laying Vessel(CLV): Furukawa Electric 古河電気工業株式会社 etc.
  • Service Operations Vessel (SOV): Tokyo Kisen 東京汽船株式会社 etc.
  • Digital Platform: TEPCO RP 東京電力 リニューアブルパワー, Toshiba 東芝, Hokutaku 株式会社北拓, NTN Corporation, Toda Corporation 戸田建設株式会社

Finance

Potential providers of wind/solar finance

The Japan Renewable Energy (JRE) purchase deal by Eneos Holdings was $1.8 billion in 2021.[95]

According to GWEc's report, the METI allocated JYP 119.5 billion ($940 million) in October 2021 for a 12 years cost reduction project, with the first 3-5 years for component technology development and a maximum of 8 years for testing and demonstration. The purpose of this finance is to achieve a generation cost of JPY 8-9/kWh (EUR0.06-0.07/kWh) with seafloor-mounted turbine by 2030. [20]

Several companies will contribute innovation funding to offshore wind technologies under the Green Innovation Fund allocated by METI [11][97]

  • Phase 1(3-5 years): Development of elemental technologies with a budget amount of up to JYP 34.5 billion yen
  • Phase 2(up to 8 years): Demonstration of floating system with a budget amount of up to JYP 85 billion yen


The details of different phases and the allocation of the fund can be seen from the report: NEDO’s activities toward expansion of offshore wind power generation 洋上風力発電の導入拡大に向けたNEDOの取り組み について[58] and the NEDO Green Innovation Fund Project for Reducing the Cost of Offshore Wind Power Generation[98]

Moreover, the Ministry of Economy, Trade and Industry established a Green Innovation Fund to provide ongoing support to companies working to advance clean energy and economic goals through research and development, demonstration projects, and implementation. The fund will last for 10 years and is valued at 2 trillion yen. Reducing costs of offshore wind projects is one priority area for the fund.[99]

Finally, the Ministry of Economy, Trade and Industry launched the Basic Policy for Realization of GX (Green Transformation) which will leverage 20 trillion yen to foster economic growth, achieve carbon neutrality, and build a strong supply of energy by 2050. The Policy will leverage 150 trillion yen in public-private funding within the next ten years.[100]

Feed-in Tariff

Renewable energy development in Japan is supported by feed-in tariffs, which were first introduced in 2012. The tariff rate is locked in for 20 years after the project begins operation. In addition, a feed-in premium program was established in 2021 which allows power producers to sell electricity at market price plus a fixed premium. Projects tendered in Round 1 were supported by feed-in tariffs whereas Round 2 projects were supported by feed-in premiums.[101]

Other

Articles and resources

Related GEM.wiki articles

References

  1. Intended Nationally Determined Contributions (INDC): Greenhouse Gas Emission Reduction Target in FY2030 Ministry of Foreign Affairs of Japan, July-26-2021
  2. Japan’s Nationally Determined Contribution (NDC) UNFCCC, June-2022
  3. Japan’s Roadmap to “Beyond-Zero” Carbon Ministry of Economy, Trade and Industry, Japanese Government, 2021
  4. 4.0 4.1 “FY2022 Energy Supply and Demand Report (Preliminary Report),” Ministry of Economy, Trade and Industry, November 29 2023
  5. 5.0 5.1 5.2 5.3 “Aggregation of Electricity Supply Plans for Fiscal Year 2023,” Organization for Cross-regional Coordination of Transmission Operators Japan, October 2023
  6. 6.0 6.1 Sectoral Study: Analysis of the offshore wind tender results in Japan European Commission, October 2022
  7. 7.0 7.1 秋田港および能代港における洋上風力発電プロジェクトの全面商業運転開始について~国内初となる大型洋上風力発電所が全面商業運転開始~ Tohoku Electric Power Co 東北電力トップページ, Jan-31-2023
  8. Trends in Generating Capacity by Power Source, 2021–2031 OCCTO 電力広域的運営推進機関, The Electric Power Industry in Japan 2023, Japan Electric Power Information Center, Inc. (JEPIC), 2023
  9. Rapid Progress for Japan’s Offshore Wind Ambitions Power Mag, Sep-1-2022
  10. Market analysis: Japan to reach 10 GW offshore wind capacity by 2030 InfoLink Group, Nov-17-2021
  11. 11.00 11.01 11.02 11.03 11.04 11.05 11.06 11.07 11.08 11.09 11.10 Introduction of Japan’s Offshore Wind Policy Energy Efficiency and Renewable Energy Dept., Agency for Natural Resources and Energy, METI, Keisuke MUTO, July 2022
  12. JAPAN'S ENERGY - 10 questions for understanding the current energy situation METI Japanese Government, Feb 2023
  13. 13.00 13.01 13.02 13.03 13.04 13.05 13.06 13.07 13.08 13.09 13.10 Vision for Offshore Wind Power Industry(1st) METI Ministry of Economy, Trade and Industry, Japanese Government, December-15-2020
  14. “Strategic Energy Plan,” Ministry of Economy, Trade and Industry, October 2021
  15. 15.0 15.1 Wind industry aims to provide a third of Japan's power by 2050 Economic Times Energy World, May-30-2023
  16. 16.0 16.1 16.2 Rapid Progress for Japan’s Offshore Wind Ambitions POWER, Sep-1-2022
  17. “Proposal for the 2035 Energy Mix (First Edition),” Renewable Energy Institute, May 18 2023
  18. “JWPA Wind Vision 2023,” Japan Wind Power Association, May 2023
  19. 19.0 19.1 19.2 19.3 Asia: The Next Frontier for the Offshore Wind Industry Asia Wind Energy Association&, Nov-4-2018
  20. 20.0 20.1 20.2 20.3 20.4 20.5 20.6 GWEC|GLOBAL OFFSHORE WIND REPORT 2022 GLOBAL WIND ENERGY COUNCIL, June-29-2022
  21. NeoWins 洋上風況マップ NEDO, New Energy and Industrial Technology Development Organization 国立研究開発法人新エネルギー・産業技術総合開発機構, 2022
  22. 22.0 22.1 22.2 22.3 Global Energy Monitor, Global Wind Power Tracker, December 2023 release.
  23. 秋田県秋田港及び能代港における洋上風力発電プロジェクトの全面商業運転開始について 丸紅株式会社, Jan-31-2023
  24. 秋田の洋上風力が全33基運転開始 電気新聞, Feb-1-2023
  25. 秋田県秋田港および能代港における洋上風力発電プロジェクトの運転を開始 中部電力株式会社 Chubu Electric Power Co, Jan-31-2023
  26. 酒田港の波・風 > 風力発電 国土交通省 東北地方整備局 酒田港湾事務所, March-14-2022
  27. 再エネ海域利用法に基づく区域指定・事業者公募の流れ METI, May-23-2023
  28. Construction started for Nagasaki-Goto floating offshore wind farm (2.1MW x 8units= 16.8MW, spar type) JAPAN WIND POWER ASSOCIATION, Oct-7-2022
  29. 29.0 29.1 秋田県能代市、三種町及び男鹿市沖洋上風力発電事業 概要説明 秋田能代・三種・男鹿オフショアウィンド合同会社, 国土交通省, Sep-27-2022
  30. 30.0 30.1 秋田県由利本荘市沖(北側・南側)洋上風力発電事業 概要説明 秋田由利本荘オフショアウィンド合同会社, Sep-27-2022
  31. 31.0 31.1 千葉県銚子市沖 洋上風力発電事業 概要説明 千葉銚子オフショアウィンド合同会社, Nov-21-2022
  32. 32.0 32.1 洋上風力めぐる3商社の思惑…「強者」三菱商事、英BPとタッグの丸紅、陸上トップの豊田通商 BUSINESS INSIDER JAPAN, July-27-2022
  33. Notice of Losses on Investments in Affiliate and Revision to Full-year Consolidated Forecasts (IFRS) RENOVA, Inc., Jan-7-2022
  34. 秋田県八峰町及び能代市沖洋上風力発電に係る事業者公募について 国土交通省, Retrieved June-29-2023
  35. 【第2ラウンド動向】 秋田県八峰町、能代市沖の公募の行方 WIND JOURNAL, Jan-10-2023
  36. 三菱商事洋上風力 秋田県沖第2ラウンド事業の環境アセス中止 WIND JOURNAL, Dec-9-2022
  37. 37.0 37.1 【第2ラウンド動向】長崎県西海市江島沖の公募の行方 WIND JOURNAL, Jan-12-2023
  38. 【第2ラウンド動向】秋田県男鹿市、潟上市、秋田市沖の公募の行方 WIND JOURNAL, Jan-10-2023
  39. 39.0 39.1 新潟村上市・胎内市沖での洋上風力発電事業、SSEパシフィコ(東京)が計画 新潟日報, June-10-2023
  40. 北海道石狩湾沖で大規模発電計画ラッシュ WIND JOURNAL, Feb-23-2023
  41. 41.0 41.1 41.2 41.3 令和4年度に実施した系統確保スキームに 関する調査事業について 経済産業省資源エネルギー庁, May-12-2023
  42. 資料5_青森県沖日本海(南側)の区域概要図 国土交通省, Dec-25-2020
  43. 遊佐沖の洋上風力、次々に行われる環境アセスメント。最大のテーマは地域共生か WIND JOURNAL, Aug-2-2022
  44. (仮称)九十九里沖洋上風力発電事業 株式会社ユーラスエナジーホールディングス Ministry of Economy, Trade and Industry, Japanese Government, Nov-30-2022
  45. (仮称)いすみ市沖洋上風力発電事業に係る計画段階環境配慮書に対する環境大臣意見の提出について 環境省, Nov-18-2022
  46. (仮称)洋野風力発電事業 岩手県庁, March-1-2023
  47. 環境影響評価 福岡県庁, Retrieved June-29-2023
  48. (仮称)薩摩洋上風力発電事業 アカシア・リニューアブルズ株式会社及び三井不動産株式会社 Ministry of Economy, Trade and Industry, Japanese Government, Jan-20-2020
  49. 風力発電所一覧 Ministry of Economy, Trade and Industry, Japanese Government, June-23-2023
  50. Japan aims to shut down 100 inefficient coal plants within decade TheJapanTimes, July-2-2020
  51. Japan reiterates plan to cut reliance on coal REUTERS, May-27-2022
  52. 【News】With no coal exit policy, Japan falls short at COP26 Japn Beyond Coal, Jan-7-2022
  53. Japan, US and EU block G7 from setting coal phase out date Climate Home News, April-17-2023
  54. Just Transitions in Japan Just Transitions to Decarbonisation in the Asia-Pacific The British Academy, 2022
  55. Global Wind Workforce Outlook 2022 - 2026 Global Wind Organization & Global Wind Energy Council, Sep-2022
  56. Renewable Energy and Jobs Annual Review 2023 IRENA and ILO (2023), Renewable energy and jobs: Annual review 2023, International Renewable Energy Agency, Abu Dhabi and International Labour Organization, Geneva.
  57. “Socioeconomic Analysis of Offshore Wind Power Development in Japan,” Renewable Energy Institute, December 2022
  58. 58.0 58.1 NEDO’s activities toward expansion of offshore wind power generation 洋上風力発電の導入拡大に向けたNEDOの取り組み について Shunsuke Saegusa, Offshore Wind & Ocean Energy, New Energy Technology Dept., New Energy and Industrial Technology Development Organization (NEDO), Nov-8-2022
  59. 59.0 59.1 59.2 59.3 Japan eyes offshore wind farms beyond territorial waters NIKEI ASIA, April-19-2023
  60. Coal Power in Japan Japan Beyond Coal, 2020
  61. 61.0 61.1 釧路火力発電所について No Coal Kushiro 釧路火力発電所を考える会, 2020
  62. 蒲生干潟自然再生協議会 宮城県公式Webサイト, May-31-2023
  63. 63.0 63.1 63.2 仙台・石炭火力発電所計画の問題 仙台港の石炭火力発電所建設問題を考える会, 2018
  64. 神戸の石炭火力発電問題って何? Citizens’ Committee on the Kobe Coal-Fired Power Plant 神戸の石炭火力発電を考える会, Retrieved in June 2023
  65. 65.0 65.1 65.2 Offshore wind power next big thing in Japan’s green push? THE ASAHI SHIMBUN, Feb-1-2023
  66. 「操業に影響」漁業者が懸念 いすみ市沖の洋上風力発電 東京新聞 Tokyo News, December-15-2022
  67. About Japan Beyond Coal Japan Beyond Coal, 2020
  68. 68.0 68.1 No Coal Tokyo Bay 石炭火力を考える東京湾の会 No Coal Tokyo Bay 石炭火力を考える東京湾の会, 2020
  69. GENESIS松島計画の何が問題なのでしょうか? ACT松島, Retrieved in June 2023
  70. Japanese Law Translation Database System Japanese Law Translation Database go.jp, Retrieved in May-24-2023
  71. “Port and Harbour Act,” Japanese Law Translation, Retrieved April 5 2024
  72. METI releases the Cabinet decision on the 6th Strategic Energy Plan EnvilianceAsia, No-5-2021
  73. エネルギー基本計画 METI Ministry of Economy, Trade and Industry, Japanese Government, October 2021
  74. エネルギー基本計画の概要 資源エネルギー庁 METI Ministry of Economy, Trade and Industry, Japanese Government, October 2021
  75. 75.0 75.1 Green Growth Strategy Through Achieving Carbon Neutrality in 2050 METI Ministry of Economy, Trade and Industry, Japanese Government, Oct-17-2022
  76. Offshore wind pwr. Solar, heat energy METI Ministry of Economy, Trade and Industry, Japanese Government, Retrieved in May-24-2023
  77. 77.0 77.1 洋上風力の産業競争力強化に向けた官民協議会 Ministry of Land, Infrastructure, Transport and Tourism, 2021
  78. First Meeting of Public-Private Council on Enhancement of Industrial Competitiveness for Offshore Wind Power Generation to be Held Ministry of Economy, Trade and Industry, Japanese Government, July-9-2020
  79. Nippon Export and Investment Insurance (NEXI) Nippon Export and Investment Insurance (NEXI), Retrieved in May-26-2023
  80. “About Us,” Japan Wind Energy Association, Retrieved April 5 2024
  81. “Purpose,” Renewable Energy Association for Sustainable Power Supply, Retrieved April 5 2024
  82. “Expectation and Foresight of FOW in Japan,” Japan's Floating Offshore Wind Group, September 2021
  83. “Offshore wind development and regulation in Japan,” DLA Piper, April 4 2024
  84. Japan to hit 6 GW of offshore wind capacity by 2030 Splash247.com, April-14-2023
  85. “Japan Offshore Wind Update – Round 2 Results & Round 3 Process,” White & Case, April 8 2024
  86. “Japan’s offshore wind power policy: overview and recent developments,” The GR Company, December 2023
  87. “Japan selects 5 promising zones for offshore wind farms,” Reuters, May 12 2023
  88. 88.0 88.1 全国の送電網強化に最大7兆円の投資必要 整備計画まとまる NHK, March-30-2023
  89. 89.0 89.1 送配電網の変遷と現状の課題とは? 電力ネットワークのこれからの姿 HATCH, May-23-2022
  90. 電力ネットワークの次世代化に向けた中間とりまとめ(案) METI 資源エネルギー庁, June-3-2021
  91. OSW Project Areas & Transmission Lines (beta version) Renewable Energy Institute 自然エネルギー財団, Retrieved in June-5-2023
  92. 北海道石狩湾沖で大規模発電計画ラッシュ WIND JOURNAL JP, Feb-28-2023
  93. Global Energy Monitor, Global Coal Plant Tracker, January 2024 release.
  94. "Global Oil and Gas Plant Tracker," Global Energy Monitor, February 2024.
  95. 95.0 95.1 Refiner Eneos to buy Japan Renewable Energy for $1.8 bln Reuters, Oct-11-2021
  96. Cost Reductions for Offshore Wind Power Generation METI, Japanese Government, Jan-11-2023
  97. Green Innovation Fund METI, Ministry of Economy, Trade and Industry, Japanese Government, Feb-3-2023
  98. NEDO Green Innovation Fund Project for Reducing the Cost of Offshore Wind Power Generation TEPCO Renewable Power, Retrieved in May-30-2023
  99. “Green Innovation Fund,” Ministry of Economy, Trade and Industry, Retrieved April 5 2023
  100. “Basic Policy for Realization of GX (Green Transformation),” Ministry of Economy, Trade and Industry, Retrieved April 5 2024
  101. “Global offshore wind: Japan,” Norton Rose Fulbright, July 2023
