Guizhou Gas Pipeline Network

From Global Energy Monitor
Part of the
Global Gas Infrastructure Tracker,
a Global Energy Monitor project.
Download full dataset
Report an error
Related categories:

Guizhou Gas Pipeline Network 贵州天然气管网, is a pipeline network in Guizhou Province, China with pipelines that are proposed, in development, and operating.

Location

The Guizhou Gas Pipeline Network runs throughout Guizhou Province, China.

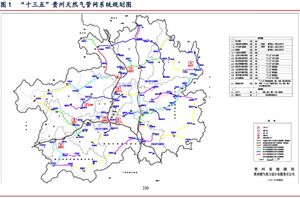

Guizhou Gas Pipeline Proposal-13th FYP.jpg
Loading map...

Background

Prior to 2014, Guizhou Province had limited access to natural gas, and coal served as the major source of energy for residents and industry in the province. In early 2014, two national pipelines — Sino-Myanmar Gas Pipeline and Zhongwei-Guiyang Connecting Pipeline — began operating and brought natural gas to the province.[1] This network and expansion of Guizhou's natural gas infrastructure began in 2015 with the province's 13th Five-Year Plan (2016-2020), which aimed to make natural gas the primary energy source for the province.[2]

The network uses a "three-level" network system and aims to provide natural gas to 85% of the municipal population.[3] The main framework of Guizhou's natural gas comes from its source pipelines, namely the Sino-Myanmar Gas Pipeline, China-Guizhou Line (中贵线), and Chongqing-Guizhou-Guangxi Gas Pipeline[3]. These source pipelines serve as the backbone for eight provincial branches that feed into 45 county-level pipelines[2]. By 2025, the entire network is expected to exceed 4000 kilometers of built pipeline.[4]

In 2019, the province issued the "Natural Gas Reaching Every County Implementation Plan" 贵州省天然气“县县通”行动方案 to accelerate natural gas distribution.[5] By 2020, three provincial branches and 18 county-level pipelines were completed, with a total of 2363 kilometers of pipeline.[6] However, as of June 2020, construction progress was falling behind on major pipeline projects, reaching only 25% of its expected completion for 2020.[7]

Several trans-province gas pipelines, including Sichuan-Yunnan-Guizhou-Guangxi Regional Gas Pipeline, Tongren-Fenghuang (Hunan), Yuping-Xinhuang (Hunan), Chongqing-Zheng'an (Guizhou), and Sino-Myanmar Gas Pipeline 45 valve chamber (中缅 45#阀室)—Hechi (Guangxi) are planned for construction. Preliminary work on Nanchuan (Chongqing)-Daozhen pipeline is also being promoted for construction.[4]

The province also plans to expand coal-bed methane gas as well as shale natural gas in the future, to provide further natural gas infrastructure in the province.[8]

In October 2021, Guizhou province issued its 14th Five-Year-Plan for oil and gas industry. It indicates that by the end of 2020, there was already 2577 kilometers of gas pipeline being built in the province, including 553 km of Sino-Myanmar Gas Pipeline, 356 km of Zhongwei-Guiyang Connecting Gas Pipeline and 1668 km of provincial branches. 62 counties and one new district are reached by gas pipeline.

It also plans to build more than 2000 km of gas pipeline during the 14th Five-Year-Plan period which is from 2021 through 2025. The total gas pipeline mileage will reach 4000 km by 2025 and 6400 km by 2035. [9]

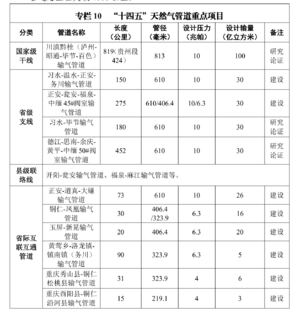

Major individual segments discussed in the province's 14th Five-Year Plan are described on the side bar.[9]

Network details

Some of the major segments found in research are listed below. This network as a whole is considered in the Construction phase because some of the pipelines are still in development and not operational.

  • Owner: Guizhou Natural Gas Pipeline Network Co Ltd 贵州天然气管网有限责任公司[10]
  • Parent company: Guizhou Wujiang Energy Group Co Ltd 贵州乌江能源集团有限责任公司[10]
  • Length:
  • Diameter:
  • Status: Construction
  • Start year:
  • Cost:
  • Financing:
  • Associated infrastructure:

Trunk lines 干线

Kaili-Tongren Gas Pipeline 主干线凯里-铜仁

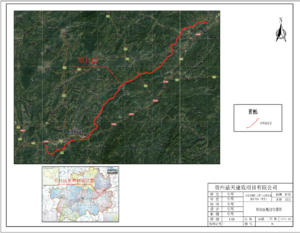

Screenshot 2024-08-27 at 12.19.42 PM.png
Loading map...
  • Owner: Guizhou Three Gorges Kaitong Energy Co Ltd[11]
  • Parent:
  • Capacity: 0.956 billion cubic meters per day[12]
  • Length: 205.8 kilometers total[12]
    • Duyun to Kaili: 67 kilometers[13]
    • Kaili to Tongren: 200 kilometers[13]
  • Diameter: DN 323.9 millimeters[12]
  • Status: Operating[11]
  • Start year: 2021[11]
  • Cost: 826 million RMB[13]
    • Duyun to Kaili: 270 million RMB[13]
    • Kaili to Tongren: 556 million RMB[13]

Main Line Zunyi-Zheng'an Segment 主干线遵义-正安 (遵义-绥阳-正安天然气输气管道)

The ventilation of this pipeline marks the interconnection of Zunyi and Chongqing natural gas pipelines and the smooth flow of Zheng'an shale gas export channels. The pipeline runs from Xinzhou Distribution Station, Xinpu New District, Zunyi,to Zheng'an Distribution Station, Zheng'an County, Zunyi. It is connected with the already built Zheng'an-Daozhen-Dalian gas pipeline, forming the main channel for "Chongqing gas into Guizhou" .[14]

Loading map...

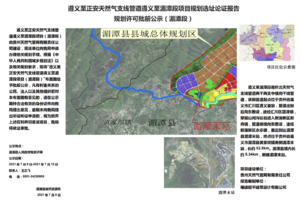

Qianbei Pipeline Network Zhengan-Xishui 黔北管网正安-习水(正安至习水天然气支线管道)

The pipeline is located in Zunyi City, Guizhou Province, and four new distribution stations will be built in Xishui, Wenshui, Dingshan and Zheng'an.[16]The Wenshui to Xishui section (55 km) entered trial operation on October 20, 2023.[17]

Loading map...
  • Owner: Guizhou Shale Gas Exploration and Development Co Ltd[16]
  • Parent company:
  • Capacity: 3.5 bcm/y[16]
  • Length: 221.8 km[16]
  • Diameter: 500 mm[16]
  • Status: Operating (Wenshui-Xishui section)[17] (Dingshan-Wenshui section 31.9km)[18]
  • Start year: 2023[17]
  • Cost:

Qianbei Pipeline Network Zhengan-Wuchuan 黔北管网正安-务川

Branch line for the Guizhou Natural Gas Pipeline Network.[4]This pipeline is also an important part of Guizhou Province's natural gas "county-county connection". It runs from the Zheng'an branch station, Green Town, Zheng'an County, Zunyi, to the Wuchuan branch station, Duru Town, Wuchuan County, Zunyi.[19]

Loading map...
  • Owner: National Pipe Network Group Guizhou Pipe Network Co Ltd[20]
  • Parent company:
  • Capacity: 0.44 bcm/y[21]
  • Length: 50.8 km[20]
  • Diameter: 400 mm[20]
  • Status: Operating[22]
  • Start year: 2024[22]
  • Cost: 329.11 million RMB[21]
  • Financing: Enterprise self-financing[20]
  • Associated infrastructure:

Zunyi-Hezhang Gas Pipeline 遵义-赫章天然气管道

The pipeline is one of the key projects to achieve the goal of "gasifying Bijie". It runs from the Zunyi South Branch Station of the Zhongwei-Guiyang Connecting Gas Pipeline, Bozhou District, Zunyi, to Baiguo Town, Hezhang County, Bijie.[23]

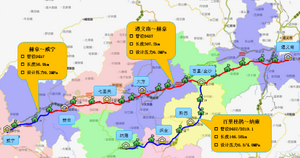

Zunyi-Hezhang Gas Pipeline (the red line)
Loading map...

Provincial Interconnection Pipelines 省级互联互通管道

Zheng'an-Daozhen-Dalian gas pipeline 正安-道真-大磏输气管道(渝气入黔正大线)

This pipeline is the main channel for Chongqing gas to enter Guizhou and is a key project in Guizhou’s “14th Five-Year Plan” to accelerate the construction of natural gas pipeline networks. It is also an important export channel for shale gas in northern Guizhou. It runs from Zheng'an County, Zunyi, to Dalian Town, Daozhen County, Zunyi.[25][26]

Loading map...

Huangying-Luolong-Zhennan gas pipeline 黄莺乡-洛龙镇-镇南镇(务川)输气管道

This pipeline is an inter-provincial (Guizhou and Chongqing) interconnection pipeline and is included in the "Guizhou Province's "14th Five-Year Plan" Oil and Gas Industry Development Plan".[9]It runs from Huangying Town, Wulong District, Chongqing, to Zhennan Town, Wuchuan County, Zunyi, Guizhou province.

Loading map...
  • Owner:
  • Parent:
  • Capacity: 0.5 bcm/y[9]
  • Length: 90 km[9]
  • Diameter: 323.9 mm[9]
  • Status: Proposed[29]
  • Start year:
  • Cost:
  • Associated infrastructure:

Branch Lines 支线

Dushan Branch Pipeline 独山天然气支线管道

Loading map...
  • Owner: Guiyang Oil and Gas Transportation Branch of State Pipe Network Group Southwest Pipeline Co Ltd[30]
  • Capacity: 0.733 billion cubic meters per day[31]
  • Length: 11.55 kilometer[30]
  • Diameter: 219.1 mm[31]
  • Status: Operating[30]
  • Start year: 2023[30]
  • Cost:

Dushan-Pingtang-Luodian Branch Pipeline 独山-平塘-罗甸天然气支线管道工程 (独山-平塘段)

Loading map...
  • Owner: Guiyang Oil and Gas Transportation Branch of State Pipe Network Group Southwest Pipeline Co Ltd[32]
  • Parent:
  • Capacity: 0.15 billion cubic meters per year[33]
  • Length: 17.3 kilometer[33]
  • Diameter: 323.9 mm[34]
  • Status: Operating[35]
  • Start year: 2023[35]
  • Cost: 120 million RMB[34]
  • Associated infrastructure: Sino-Myanmar Gas Pipeline[34]
  • Connects Dushan County's Baiquan Township to Pingtang County and to Luodian County

Jinsha-Qianxi-Nayong Branch Pipeline 金沙-黔西-织金-纳雍支线管道

Zunyi-Hezhang Gas Pipeline (the bule line at the right)
Loading map...

Hezhang-Weining Gas Pipeline 赫章-威宁输气管道

This pipeline runs from Hezhang County, Bijie, to Weining County, Bijie.[40]

Zunyi-Hezhang Gas Pipeline (the bule line at the left)
Loading map...

Zunyi-Meitan Branch Pipeline 遵义-湄潭天然气支线管道

The pipeline starts from the Zunyi Transmission Station on the Zhongwei-Guiyang Connecting Gas Pipeline, passes through Xinzhou Town and Yongle Town in Xinpu New District, Zunyi, and reaches the Meitan Terminal Station.[43]

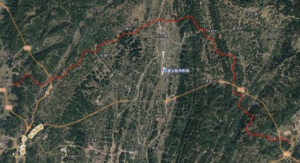

Screenshot 2024-08-29 at 3.04.55 PM.png
Loading map...

Meitan-Sinan Branch Pipeline 湄潭-思南天然气支线管道

The pipeline starts from Meitan Station in Xinjie Village, Meijiang Town, Meitan County, Zunyi City, passes through Meitan County, Fenggang County, Dejiang County, Sinan County, and ends at Sinan Station in Shuangtang Office, Sinan County, Tongren City.[47]

Loading map...
  • Operator:
  • Owner: Sinnan Junling Energy Co., Ltd. (思南峻岭能源有限公司)[As of 2024-05-31, the company is seeking restructuring.][48]
  • Parent:
  • Capacity: 68.5×104m3/d[47]
  • Length: 107.5 km[47]
  • Diameter: 406.4 mm[48]
  • Status: Shelved (102.48km was built)[48]
  • Start year:
  • Cost: 426 million RMB[47]
  • Financing:
  • Associated infrastructure: Zunyi-Meitan Gas Pipeline


Wuchuan-Dejiang Gas Pipeline 务川-德江输气管道

The pipeline runs from Duru Street, Wuchuan County, Zunyi, to Yantang Tujia Town, Dejiang County,Tongren,passing through Nangan Tujia Town, Longquan Tujia Town and Qinglong Town in Dejiang County.[49]

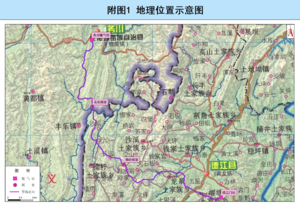

Screenshot 2024-08-28 at 3.08.33 PM.png
Loading map...

Duyun-Kaili Gas Pipeline 都匀-凯里省级天然气支线管道

The pipeline starts from Duyun City, Qiannan Prefecture, passes through Majiang County, Bibo Economic Development Zone, Kaili Economic Development Zone, and reaches Xiasi Town, Kaili. The whole pipeline is in Qiannan Buyi and Miao Autonomous Prefecture.[51]

Loading map...

Xinzhou-Suiyang-Zheng'an Gas Pipeline 新舟-绥阳-正安输气管道

This pipeline is the north-south main line of the gas pipeline network in northern Guizhou and is an important part of the "county-county connection" of gas in Guizhou Province. It starts from Xinzhou Distribution Station on the west side of Xinzhou Town, Xinpu New District, Zunyi, passes through 3 districts and counties, including Xinpu New District, Suiyang County, and Zheng'an County, and ends the Zheng'an Distribution Station at Guanlong Village, Gelin Town, Zheng'an County, Zunyi.[53]The pipeline is connected to the Zheng'an-Daozhen-Dalian Gas Pipeline that carries Chongqing gas into Guizhou.[28]

Loading map...

Xiuwen-Kaiyang Gas Pipeline 修文-开阳输气管道

This pipeline runs from Xiuwen Distribution Station of Zhongwei-Guiyang Connecting Gas Pipeline, Longchang Town, Xiuwen County, Zunyi, to Shuangliu Town, Kaiyang County, Guiyang.[56]

Loading map...

Tongren City County-to-County Gas Pipeline Project 铜仁市天然气管道县县通工程

Tongren City County-to-County Gas Pipeline is a key component of the Guizhou Province County-to-County Natural Gas Access Action Plan. The entire pipeline is located in Tongchuan City. It originates at the Yuping Initial Station in Yuping Dong Autonomous County, passes through Tongren's Bijiang District, Dalong Economic Development Zone, High-Tech Industrial Development Zone, Wanshan District, Jiangkou County, Shiqian County, Sinan County, Yinjiang Tujia and Miao Autonomous County, and Dejiang County, before terminating at the Yanhe Terminal Station in Yanhe Tujia Autonomous County.[58]As of July 2024, the Jiangkou-Sinan Section is under construction.The pipeline also includes six branch lines.[59]

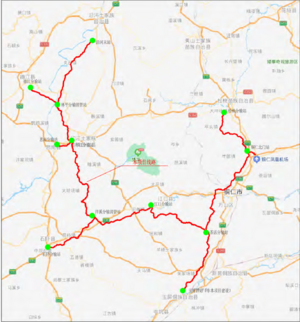

铜仁市天然气管道县县通管道路线
Loading map...
  • Owner: Tongren Energy Investment Group Co Ltd[58]
  • Parent:
  • Capacity: 0.829 bcm/y[58]
  • Length: 393 km[58]
  • Diameter: 406.4/323.9 mm[58]
  • Status: Construction[59]
  • Start year:
  • Cost: 1965 million RMB[58]

Ala-Wanshan Gas Pipeline 阿拉-万山输气管道

This pipeline is one of the pipelines in the Tongren City Gas Pipeline County-to-county Project.[60]

Loading map...
  • Owner: Tongren Energy Investment Group Co Ltd[58]
  • Parent:
  • Capacity:
  • Length: 62 km[60]
  • Diameter: 400 mm[60]
  • Status: Construction[59]
  • Start year:
  • Cost: 310 million RMB[60]

Jiangkou-Sinan Gas Pipeline 江口-思南输气管道

This pipeline is one of the pipelines in the Tongren City Gas Pipeline County-to-county Project.[60]

Loading map...
  • Owner: Tongren Energy Investment Group Co Ltd[58]
  • Parent:
  • Capacity:
  • Length: 79 km[60]
  • Diameter: 400 mm[60]
  • Status: Construction[59]
  • Start year:
  • Cost: 395 million RMB[60]

Houba-Yanhe Gas Pipeline 后坝-沿河输气管道

This pipeline is one of the pipelines in the Tongren City Gas Pipeline County-to-county Project.[60]

Loading map...
  • Owner: Tongren Energy Investment Group Co Ltd[58]
  • Parent:
  • Capacity:
  • Length: 68 km[60]
  • Diameter: 300 mm[60]
  • Status: Construction[59]
  • Start year:
  • Cost: 340 million RMB[60]

Qiandongnan Prefecture County-to-County Gas Pipeline 黔东南州县县通天然气管道项目

The project aims to provide gas pipeline access to all 16 counties and cities under the jurisdiction of Qiandongnan Prefecture: Kaili City, Majiang County, Danzhai County, Leishan County, Taijiang County, Jianhe County, Sansui County, Zhenyuan County, Cengong County, Tianzhu County, Huangping County, Shibing County, Jinping County, Liping County, Rongjiang County, and Congjiang County.[61]The total length is about 698 kilometers. Gas transmission capacity: 1.296 bcm/y.[62]

Kaili-Danzhai Gas Pipeline 凯里-丹寨输气管道

The pipeline starts from Huilong Village, Xiasi Town, Kaili Economic Development Zone, passes through Majiang County, and reaches Hongyan Village, Changqing Township, Danzhai County.[63]

Loading map...

Yangmanshao-Tianzhu Gas Pipeline 羊满哨-天柱输气管道

This pipeline runs from Yangmanshao Distribution Station, Yangmanshao Village, Jinbao Township, Zhenyuan County, Qiandongnan Miao and Dong Autonomous Prefecture, to Tianzhu Distribution station, Zixi Village, Bangdong Town, Tianzhu County, Qiandongnan Miao and Dong Autonomous Prefecture.[66]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[67]
  • Parent:
  • Capacity:
  • Length: 90.24 km[67]
  • Diameter: 300 mm[67]
  • Status: Construction[68]
  • Start year:
  • Cost: 298.20 million RMB[69]

Kaili-Leishan Gas Pipeline 凯里-雷山天然气管道

The pipeline starts from the Kaili-Tongren Gas Pipeline 2# Distribution Valve Room in Longjing Village, Sankeshu Town, Kaili City, and ends at the Leishan Transmission Station in Zhangpai Village, Danjiang Town, Leishan County.[62]

Loading map...

Taipan-Jianhe Gas Pipeline 台盘-剑河天然气管道

The pipeline starts from the Taipan Transmission Station in Nanyao Village, Taipan Township, Taijiang County, and ends at the Jianhe Transmission Station in Fanglong Village, Gedong Town, Jianhe County.[71]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[71]
  • Parent:
  • Capacity:
  • Length: 35.19 km[71]
  • Diameter: 300 mm[71]
  • Status: Construction[72]
  • Start year:
  • Cost: 108.3745 million RMB[71]

Zhenyuan-Yangmanshao Gas Pipeline 镇远-羊满哨天然气管道

The pipeline starts from the Zhenyuan Transmission Station in Tianba Village, Yongxi Township, Zhenyuan County, and ends at the Yangmanshao Transmission Station in Yangmanshao Village, Jinbao Township, Zhenyuan County.[73]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[73]
  • Parent:
  • Capacity:
  • Length: 10.26 km[73]
  • Diameter: 200 mm[73]
  • Status: Construction[74]
  • Start year:
  • Cost: 30.7246 million RMB[73]

Kaili-Huangping Gas Pipeline 凯里-黄平输气管道

The pipeline starts from the Kaili Transmission Station in Xiasi Town, Kaili Economic Development Zone, and ends at the Huangping Transmission Station in Laozhai Village, Xinzhou Town, Huangping County.[75]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[75]
  • Parent:
  • Capacity: 0.008818 bcm/y[75]
  • Length: 52.78 km[75]
  • Diameter: 300 mm[75]
  • Status: Construction[59]
  • Start year:
  • Cost: 196.0504 million RMB[76]

Tianzhu-Congjiang Gas Pipeline 天柱-从江天然气管道

The pipeline is the second phase of the Qiandongnan Prefecture's inter-county natural gas pipeline project. It starts at the Tianzhu Gas Transmission Station in Tongyouwan Village, Bangdong Town, Tianzhu County, and ends at the Congjiang Gas Transmission Station in Luanli Village, Congjiang County.[77] The pipeline is divided into the Tianzhu-Liping Segment and the Liping-Congjiang Segment.

Loading map...

Shibing-Zhenyuan Gas Pipeline 施秉-镇远输气管道

The pipeline starts from the Shibing Transmission Station in Gaodong Village, Chengguan Town, Shibing County, and ends at the Zhenyuan Transmission Station in Gulouping Village, Yongxi Township, Zhenyuan County.[75]

Loading map...

Luoxiang to Rongjiang Gas Pipeline 洛香至榕江天然气管道

The pipeline starts from Luoxiang Transmission Station in Luoxiang Town, Congjiang County and ends at Rongjiang Transmission Station in Zhongcheng Town, Rongjiang County.[80]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[80]
  • Parent:
  • Capacity: 49.39 mill.Sm³/day[81]
  • Length: 73.53 km[80]
  • Diameter: 200 mm[80]
  • Status: Construction[82]
  • Start year:
  • Cost: 244.4538 million RMB[81]

Rongjiang to Leishan Gas Pipeline 榕江-雷山天然气管道

The pipeline starts from the Rongjiang Transmission Station in Lexiang Village, Zhongcheng Town, Rongjiang County, and ends at the Leishan Transmission Station in Zhangpai Village, Danjiang Town, Leishan County. [83]

Loading map...

Danzhai to Leishan Gas Pipeline 丹寨至雷山天然气管道

The pipeline starts from the Danzhai Transmission Station in Dalang Village, Changqing Township, Danzhai County, and ends at the Leishan Transmission Station in Zhangpai Village, Danjiang Town, Leishan County. [85]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[85]
  • Parent:
  • Capacity:
  • Length: 32.53 km[85]
  • Diameter: 200 mm[69]
  • Status: Proposed[86]
  • Start year:
  • Cost: 107.49 million RMB[69]

Huangping-Shibing Gas Pipeline 黄平-施秉输气管道

The pipeline starts from the Huangping Transmission Station in Laozhai Village, Xinzhou Town, Huangping County, and ends at the Shibing Transmission Station in Xiaohe Village, Chengguan Town, Shibing County. [87]

Loading map...
  • Owner: Guizhou Dongli Energy Investment Co Ltd[87]
  • Parent:
  • Capacity: 0.001006 bcm/y[87]
  • Length: 29.76 km[87]
  • Diameter: 200 mm[87]
  • Status: Construction[70]
  • Start year:
  • Cost: 196.0504 million RMB[87]

Other pipeline projects proposed in the province

Dejiang-Sinan-Yuqing-Huangping-#50 valve chamber gas pipeline 德江-思南-余庆- 黄平-中缅 50#阀室输气管道 Shelved
Xishui-Bijie Gas Pipeline 习水-毕节输气管道 Shelved
Yuping-Xinhuang Gas Pipeline 玉屏-新晃输气管道 Shelved
Zheng'an-Weng'an-Fuquan-#45 valve chamber pipeline 正安-瓮安-福泉-中缅#45号阀室输气管道 construction
Sino-Myanmar Fuquan Branch Pipeline 47# Valve Chamber-Dushan-Sandu Gas Pipeline 中缅47#阀室-独山-三都输气管道 Cancelled
Chishui-Xishui Gas Pipeline 赤水-习水输气管道 Proposed
Zhenning-Ziyun Gas Pipeline 镇宁-紫云输气管道 Proposed
Sino-Myanmar Fuquan Branch Pipeline 47# Valve Chamber-Pingtang-Luodian Gas Pipeline 中缅47#阀室-平塘-罗甸输气管道 Proposed
Anlong-Wangmo Gas Pipeline 安龙-望谟输气管道 Proposed
Wangmo-Luodian Gas Pipeline 望谟-罗甸输气管道 Proposed

Articles and resources

References

  1. "管道天然气正式进入贵州 开启绿色能源新时代--时政--人民网". politics.people.com.cn. Retrieved 2021-10-12. {{cite web}}: no-break space character in |title= at position 12 (help)
  2. 2.0 2.1 ""十三五" 贵州将建8条天然气支线-国际燃气网". gas.in-en.com. Retrieved 2021-10-12.
  3. 3.0 3.1 贵州省人民政府. "贵州省国民经济和社会发展第十三个五年规划纲要" (PDF). ndrc.gov.cn.{{cite web}}: CS1 maint: url-status (link)
  4. 4.0 4.1 4.2 "贵州省国民经济和社会发展第十四个五年规划和 2035 年远景目标纲要" (PDF). ndrc.gov.cn. Retrieved 2021-10-09.{{cite web}}: CS1 maint: url-status (link)
  5. "贵州省天然气"县县通"行动方案". ysdk.guizhou.gov.cn. Retrieved 2021-10-12.
  6. "贵州力争到2021年实现天然气"县县通"-新华网". m.xinhuanet.com. Retrieved 2021-10-12.
  7. "加快"油气网"建设 推动贵州油气产业高质量发展 ——专访贵州省能源局党组成员、副局长张全毅". nyj.guizhou.gov.cn. Retrieved 2021-10-12.
  8. "《贵州省天然气"县县通"行动方案》印发 - 贵州省人民政府". www.guizhou.gov.cn. Retrieved 2021-10-12.
  9. 9.0 9.1 9.2 9.3 9.4 9.5 9.6 9.7 "贵州省油气产业发展"十四五"规划--贵州省人民政府". www.guizhou.gov.cn/. 2021-10. {{cite web}}: Check date values in: |date= (help)CS1 maint: url-status (link)
  10. 10.0 10.1 "贵州天然气管网公司成立 助推全省天然气管道"县县通"". gas.in-en.com. Retrieved 2021-12-01.{{cite web}}: CS1 maint: url-status (link)
  11. 11.0 11.1 11.2 凯里至铜仁天然气支线管道项目安全设施通过竣工验收, 黔东南微报, 2022-03-15
  12. 12.0 12.1 12.2 "贵州都匀凯里铜仁天然气管道开工 将辐射黔南等多地-国际燃气网". gas.in-en.com. Retrieved 2021-10-12.
  13. 13.0 13.1 13.2 13.3 13.4 "黔东南州天然气管道项目建设基本情况". www.qdn.gov.cn. Retrieved 2021-10-12.
  14. 14.0 14.1 14.2 14.3 正安:页岩气外输畅通, 网易,2022-12-08
  15. 15.0 15.1 15.2 15.3 "遵义至绥阳至正安天然气输气管道建设项目柴油发电机组等设备采购"招标公告(二次招标), 贵州鹏业国际机电设备招标有限公司,2020-06-30
  16. 16.0 16.1 16.2 16.3 16.4 正安至习水天然气支线管道工程施工招标公告, 电力招标网,2019-12-09
  17. 17.0 17.1 17.2 温水至习水天然气输气管道项目进入试运行, 天眼新闻, 2023-10-23
  18. “气”象一新!贵州习水迎来多气源供应新格局, 央广网, 2024-09-21
  19. 正安至务川天然气输气管道项目——獠牙坝隧道全线贯通, 网易,2022-06-01
  20. 20.0 20.1 20.2 20.3 正安至务川天然气输气管道建设 项目管理承包商(PMC)与工程监理监理招标公告, 贵州鹏业国际机电设备招标有限公司, 2020-12-01
  21. 21.0 21.1 副市长李旭一行到务川调研工作, 务川县融媒体中心, 2022-03-10
  22. 22.0 22.1 遵义这条输气管道项目进入试运行!, 直播遵义, 2024年03月17日
  23. 23.0 23.1 23.2 23.3 23.4 23.5 23.6 23.7 遵义至七星关区天然气管道建成投运——毕节中心城区全面进入使用管道天然气的时代, 毕节市发展和改革委员会, 2019-01-24
  24. 织金县城镇管道天然气特许经营项目实施方案, 织金县综合行政执法局, 2022-06-03
  25. 25.0 25.1 25.2 25.3 “渝气入黔”主通道正大线试气成功, 贵州日报, 2022-06-24
  26. “渝气入黔”进黔北, 贵州省能源局, 2022-06-24
  27. 27.0 27.1 贵州天然气管网有限责任公司正安一道真-大磏天然气输气管道工程竣工环境保护验收会议纪要, 贵州天然气管网有限责任公司, 2024-09-22
  28. 28.0 28.1 28.2 以管为主 管罐结合|贵州天然气“县县通”工程建设加快步伐, 天眼新闻, 2022-10-25
  29. 关于印发《贵州省能源领域碳达峰实施方案》的通知, 贵州省能源局, 2023-01-03
  30. 30.0 30.1 30.2 30.3 "黔南州天然气"县县通"工程独山支线投产一次成功". 2023-03-29. Retrieved 2024-07-11.{{cite web}}: CS1 maint: url-status (link)
  31. 31.0 31.1 兰成渝输油管道资阳临空经济区改线工程监理, 资阳市公共资源交易中心, 2022-04-20
  32. 中石化自贡石油化工有限公司自贡舒坪油库迁建项目二标段施工评标结果公示, 自贡市公共资源交易服务中心, 2022-12-02
  33. 33.0 33.1 PipeChina (2021-02-04). "新华网:贵州天然气"县县通"工程独山至平塘段开工". www.pipechina.com.cn. Retrieved 2021-10-12.{{cite web}}: CS1 maint: url-status (link)
  34. 34.0 34.1 34.2 贵州天然气“县县通”工程独山至平塘段开工, 新华网, 2021-02-26
  35. 35.0 35.1 独山县天然气“县县通”项目正式投入运营, 金台资讯, 2023-08-29
  36. 36.0 36.1 "省水利厅关于金沙经黔西、织金至纳雍天然气支线管道水土保持方案的批复". guizhou.gov.cn.{{cite web}}: CS1 maint: url-status (link)
  37. 37.0 37.1 37.2 37.3 37.4 关于百里杜鹃经黔西、织金至纳雍天然气支线管道项目核准的通知, 贵州省发展和改革委员会, 2016-01-19
  38. "毕节城区正式进入管道天然气时代-贵州网". news.gzw.net. Retrieved 2021-10-10.
  39. 事关城镇燃气和天然气!贵州出台新方案, 毕节市七星关区人民政府, 2024-07-23
  40. 40.0 40.1 40.2 40.3 40.4 40.5 40.6 关于赫章至威宁天然气支线管道项目核准的通知, 黔东南州生态环境局, 2018-05-08
  41. 赫章至威宁天然气支线管道项目EPC总承包工程招标公告, 电力招标网, 2020-09-25
  42. 毕节市人民政府关于印发毕节市产业发展规划(2024-2030年)的通知(毕府发〔2024〕15号), 毕节市人民政府, 2024-12-24
  43. 43.0 43.1 遵义至湄潭、遵义至绥阳至正安天然气输气管道进入试气阶段, 天眼新闻, 2022-11-30
  44. 44.0 44.1 44.2 贵州:提升天然气供给能力,推进油气运行平稳, 贵州省能源局, 2024-07-17
  45. 45.0 45.1 贵州天然气管网有限责任公司遵义至湄潭天然气支线管道工程竣工环境保护验收调查报告, 贵州天然气管网有限责任公司, 2024-03
  46. 贵州省环境保护厅2012年2月17日拟批准建设项目环境影响报告表(书、登记表)公示, 贵州省生态环境厅, 2012-02-17
  47. 47.0 47.1 47.2 47.3 湄潭至思南天然气支线管道建设项目环境影响评价结论公示, 铜仁市人民政府, 2016-11-30
  48. 48.0 48.1 48.2 思南峻岭能源有限公司预重整案投资人招募公告, 铜仁市中级人民法院, 2024-05-31
  49. 49.0 49.1 49.2 49.3 49.4 49.5 49.6 务川至德江天然气输气管道项目环境影响报告书受理公示, 贵州省生态环境厅, 2022-12-05
  50. 省人民政府办公厅关于印发贵州省城镇燃气和天然气基础设施建设攻坚行动方案(2024—2027年)的通知(黔府办发〔2024〕8号), 贵州省人民政府办公厅, 2024-07-18
  51. 51.0 51.1 51.2 51.3 51.4 51.5 51.6 都匀至凯里天然气支线管道防腐工程招标公告, 采招网,2017-11-03
  52. 52.0 52.1 52.2 都匀-凯里天然气支线管道投产一次成功, 长顺在线, 2021-12-30
  53. 53.0 53.1 53.2 53.3 绥阳至正安天然气输气管道项目芙蓉江定向钻顺利回拖, 天眼新闻, 2022-05-23
  54. 贵州天然气管网有限责任公司绥阳至正安天然气输气管道项目竣工环境保护验收会议纪要, 贵州天然气管网有限责任公司, 2024-09-22
  55. 55.0 55.1 为遵义冬季能源供应助力!三条天然气输气管道项目完成竣工环境保护验收, 贵州日报, 2024-09-26
  56. 56.0 56.1 56.2 56.3 56.4 56.5 56.6 开阳县天然气输供气工程(修文至开阳天然气支线管道)项目建设项目环境影响报告表(送审本), 开阳石达天然气有限公司, 2019-02
  57. 57.0 57.1 重磅!开阳拥有了自己的专用天然气管道,开阳天然气将迎来新的春天!, 开阳石达天然气, 2018-08-14
  58. 58.0 58.1 58.2 58.3 58.4 58.5 58.6 58.7 58.8 铜仁市天然气管道县县通工程环境影响报告书( 公示版 ), 贵州省水利水电勘测设计研究院有限公司, 2023-09
  59. 59.0 59.1 59.2 59.3 59.4 59.5 贵州88个县级城区将实现管道天然气“县县通”, 贵州省城乡和住房建设厅, 2024-07-30
  60. 60.00 60.01 60.02 60.03 60.04 60.05 60.06 60.07 60.08 60.09 60.10 60.11 铜仁市天然气县县通工程项目社会稳定风险评估报告, 豆丁网, 搜索日期:2028-08-04
  61. 州人民政府办公室关于印发黔东南州天然气管道项目推进工作方案的通知, 黔东南州人民政府办公室, 2018-09-04
  62. 62.0 62.1 62.2 62.3 62.4 62.5 62.6 环境影响评价报告公示:黔东南州县县通天然气管道建设项目凯里至雷山天然气管道项目环评报告,贵州东黎城市投资股份有限公司, 2017-10
  63. 63.0 63.1 63.2 63.3 黔东南州县县通天然气管道建设项目一期一标段站场阀室成橇设备集中采购, 88查, research date: 2025-07-30
  64. 黔东南州城镇燃气和天然气基础设施建设实施方案(2024—2027年), 黔东南州人民政府办公室, 2024-08-29
  65. 65.0 65.1 环境影响评价报告公示:黔东南州县县通天然气管道建设项目凯里至丹寨天然气管道项目环评报告, 贵州东黎城市投资股份有限公司, 2017-10
  66. 黔东南州环境保护局关于2018年5月7日作出建设项目环境影响评价不予批准决定的公告(黔东南州县县通天然气管道建设项目羊满哨至天柱天然气管道项目), 黔东南州生态环境局, 2018-05-08
  67. 67.0 67.1 67.2 黔东南州县县通天然气管道建设项目台盘至剑河等天然气管道工程, 黔东南州公共资源交易中心, 2019-04-29
  68. 黔东南州天然气管道项目建设基本情况, 州发展改革委, 2020-10-10
  69. 69.0 69.1 69.2 贵州省天然气“县县通”行动方案项目表, 贵州省人民政府, 2019-07
  70. 70.0 70.1 黔东南天然气“县县通”项目建设正酣, 天眼新闻, 2024-08-22
  71. 71.0 71.1 71.2 71.3 71.4 黔东南州县县通天然气管道建设项目台盘至剑河天然气管道项目环境影响报告表, 贵州东黎城市投资股份有限公司, 2017-10
  72. 台盘至剑河等天然气管道工程开展节后复工安全检查, 中油朗威工程项目管理有限公司, 2021-03-24
  73. 73.0 73.1 73.2 73.3 73.4 环境影响评价报告公示:黔东南州县县通天然气管道建设项目镇远至羊满哨天然气管道项目环评报告,贵州东黎城市投资股份有限公司, 2017-10
  74. 黔东南州天然气管道项目建设基本情况, 黔东南州发展改革委, 2020-10-10
  75. 75.00 75.01 75.02 75.03 75.04 75.05 75.06 75.07 75.08 75.09 75.10 黔东南州县县通天然气管道建设项目二期工程社会稳定风险评估公示, 建设招标网, 2021-03-25
  76. 黔东南州县县通天然气管道工程二期项目凯里至黄平环境影响报告, 贵州东黎能源投资股份有限公司, 2019-05
  77. 77.0 77.1 77.2 77.3 77.4 77.5 77.6 黔东南州县县通天然气管道工程二期项目天柱至从江天然气管道建设项目环境影响报告书(送审稿), 贵州东黎能源投资股份有限公司, 2020-10-13
  78. 黔东南州国资委:围绕重点领域破冰  统筹推动改革提升 奋力推进国资国企改革新发展, 黔东南州国资委, 2024-09-03
  79. 79.0 79.1 黔东南州县县通天然气管道工程二期项目施秉至镇远天然气管道建设项目环评报告公示, 贵州东黎能源投资股份有限公司, 2019-10
  80. 80.0 80.1 80.2 80.3 黔东南州县县通天然气管道建设项目洛香至榕江管道工程社会稳定风险评估公示, 贵州东黎能源投资股份有限公司、贵州三和社会风险评估有限公司, 2021-03-24
  81. 81.0 81.1 关于报送《黔东南州县县通天然气管道建设项目三期工程洛香至榕江段水土保持方案报告书技术评审意见》的报告, 贵州省水利水电勘测设计研究院有限公司, 2022-12-12
  82. 州发展改革委关于州十五届人大四次会议第155J256号建议的答复, 黔东南州发展和改革委员会, 2025-06-18
  83. 83.0 83.1 83.2 83.3 83.4 83.5 83.6 黔东南州县县通天然气管道工程三期项目榕江至雷山天然气管道建设项目(公示版), 贵州东黎能源投资股份有限公司, 2020-07
  84. 黔东南州县县通天然气管道建设项目榕江至雷山天然气管道EPC总承包, 黔东南州公共资源交易中心, 2024-07-15
  85. 85.0 85.1 85.2 黔东南州生态环境局关于2020年7月28日拟作出的建设项目环境影响评价文件审批意见的公示(丹寨至雷山天然气管道建设项目、洛香至榕江天然气管道建设项目、榕江至雷山天然气管道建设项目), 黔东南州生态环境局, 2020-07-28
  86. 黔东南州县县通天然气管道建设项目丹寨至雷山、洛香至从江段总承包工程公告, 贵州招标网, 2023-12-07
  87. 87.0 87.1 87.2 87.3 87.4 87.5 黔东南州县县通天然气管道工程二期项目黄平至施秉天然气管道建设项目环评报告公示, 贵州东黎能源投资股份有限公司, 2019-10

Related GEM.wiki articles

External resources

External articles
