Taiwan Strait Offshore Wind Development

From Global Energy Monitor

Introduction

In 2022, the Taiwanese government has announced a 2050 net-zero target. Along with this commitment are offshore wind targets for short, mid-, and long-term development.

In support of offshore wind development, the Government of Taiwan is working across four pillars:[1]

  1. Policy promotion: inventorying existing offshore wind sites and infrastructure; implement strategies and supportive policy pathways.
  2. Industrial development: Build domestic manufacturing capacity; upskill marine engineering service capacity.
  3. Technological development: Continue developmental improvements on offshore wind foundations, particularly floating; reduce costs through digital operations and maintenance tools.
  4. Talent cultivation: Provide greater opportunities for advanced training, particularly in the areas of marine engineering, operations, and maintenance.

The Government of Taiwan aims to support the budding offshore wind industry, primarily through compensation standards during construction and operation, as well as a new transparent funding mechanism to share prosperity.[2] The offshore wind development in Taiwan can be segregated into three phases, detailed below:[3]

Phase 1: Demonstration Incentive Program

In this stage, the government identified the feasibility of offshore wind on its administration, technological and financial potential.[4]

The demonstrated projects received installation funding with a maximum limit of 50% of the per-watt installed capacity FIT purchase rate for the installed year and a maximum limit of NTD$ 250 million of the operational funding.[5]

Two demonstrated wind farms have started operating - Formosa 1 offshore wind farm with 128MW commissioned in 2019, Taipower Offshore wind farm with 109.2MW commissioned in 2021[3] and marked as all the demonstrated sits from phase 1 was successfully completed[5]

Phase 2: Potential Zones:

Potential Sites, Unified Wind Service Platform, Industrial Technology Research Institute

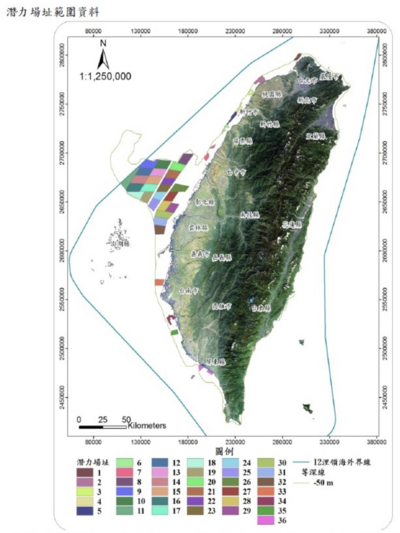

In 2015, the government announced 36 potential offshore sites.[6][7] The requirements for the developers was to pass environmental impact assessment before 2017, and received installation permit before 2019.[8] The government completed capacity allocation(first with 3.8 GW by the selection, second with 1.7GW by auction) in 2018 and is expected to be in operation by 2025[3].

Formosa 2 offshore wind farm, is the first operating farm from the selection stage of phase 2.[9][10]

Phase 3: Zonal Development

Support the long-term demand of the offshore-wind market after 2026 in Taiwan. Accelerate the sustainable development of local supply chains.[4]. In this phase, the government will conduct an integrated environmental assessment in offshore zones and then select the developers. Doing this can shorten the developing period and lower the developing cost. The government will focus on sea areas where the depths are over 50 meters and haven't gone through an environmental impact assessment. New techniques and bidding mechanism will be introduced into this phase[8]

Under the timeline, an 1.5GW of annual increase will come into operation from 2026 to 2035, with two stages of selection(Capability Review and Bidding Process). Will include Industrial Relevance Plan[3]

Current System Description

Current Installed Capacity Mix

Prospective Power Capacity

Energy Source Announced Pre-construction Construction
Gas[11] 1,396MW 16,632MW 7,211MW
Offshore Wind[12] 10,200MW 10,311MW 1,726.5MW
Onshore Wind[12] 0MW 227.8MW 0MW
Solar[13] 1,975MW 80MW 50MW
Hydropower[14] 0MW 610MW 0MW

In 2016, the government announced to phase out nuclear by 2025 and further agreed not to propose any new coal-fired power projects in 2018.

Offshore Wind in Taiwan

Renewable targets

In 2016, the authority announced the short-term goal of the energy mix in Taiwan. The country aims to phase out nuclear by 2025, reach natural gas generation to 50%, reduce coal-fired power generation to 30%, and increase variable renewable energy to 20%. Of that, the installed capacity from solar PV will be 20GW, and wind power will be 5.6GW.[15]

In 2021, the government announced further energy goals. After 2026, the annual growth of solar and offshore wind should reach 1GW and 1.5GW, respectively. By 2027, bioenergy, geothermal, and other types of renewable energy other than solar and wind are expected to increase by 16.7MW[16]

In December 2022, the 2030 energy goal was announced. The electricity generation of renewable energy should reach 27%~30%, the coal-fired power generation should further reduce to 20%, and the gas-fired power generation will remain at 50%[17]

In March 2023, the government announced the long-term 2050 net-zero goal. Renewable energy in 2050 will take 60%-70% of the electricity generation, 9%-12% will come from hydrogen, and fossil fuel sources with CCS will take up 20%-27%.[18]

The Taiwanese government has set targets for offshore wind and solar development at different stages:[19]

Energy Source 2025 2030 2035 2050
Offshore Wind 5.6GW 13.1GW[4] 20.6GW 40-55GW
Solar[4] 20GW 30GW 40-80GW
Electricity Generation from Renewables

(Including onshore wind and geothermal, and other type of energy such as biomass)

20% 27-30% 60-70%

Offshore Wind Potential

Global Wind Energy Council & Ocean Renewable Energy Action Coalition, June 2021

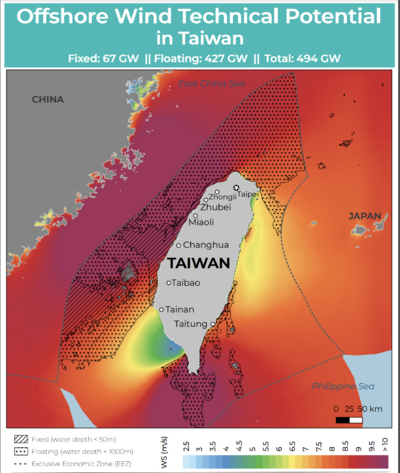

The graph in the left section shows the offshore wind potential at Taiwan Strait. From the Wind Resource Assessment Handbook,” ITRI, research in 2011, the total potential of offshore wind power in Taiwan could reach 147GW. Among that, the feasible capacity including water areas at different depths could reach at least 21.2GW.[3]

The GWEC(Global Wind Energy Council) and the OREAC(Ocean Renewable Energy Action Coalition) published in 2021 that Taiwan contains a fixed capacity of 67 GW, and a floating capacity of 427 GW, together adding up to a total of 494 GW[20]

Potential impacts from offshore wind expansion

The construction of some of the offshore wind farms has caused severe conflicts between the developers and the local fisheries community. In 2020, WPD Taiwan planned to develop 80 offshore wind generators near Yulin County. The proposed wind farms were highly overlapped with the traditional fishing area. Locals worried the catch would be negatively impacted by the construction and the operation of the farms. The local community was not able to raise their opinion at the initial stage of the construction and was not able to attend the environmental impact assessment. During a negotiation between the local fishing community and the Yunlin County Government, four people from a contract company hired by WPD came to the meeting bringing small knives. These four people claimed they were hired by WPD to conduct communication with local groups.[21] WPD later on, announced to end of the contract with the company.[22]

The biggest conflict happened at Yunlin Offshore wind farm 雲林離岸風力發電廠. Since June 2020, the working vessels of YunNeng Wind Power Company, which belonged to WPD Taiwan, have repeatedly clashed with fishermen at sea. The YunNeng Company had filed to various authorities to solve the conflicts. In August, the Yunlin County Coastal Fishing Vessels Cooperative and other organizations went to the Legislative Yuan to hold a press conference, demanding the YunNeng wind power company withdraw from the fishing grounds.[23]

Impact on Avian & Marine Animals

Indo-Pacific humpbacked dolphin(Sousa chinensis), Dr. Xiang-lin, Huang, Taiwan cetacean society, 2016
The Black-faced spoonbill, photo by Dong-hui, Guo 郭東輝, Taiwan Wild Bird Federation, 2011

The Indo-Pacific humpbacked dolphin (Sousa chinensis)[24], which is usually called the "White Dolphin", is a first-class endangered species that live in the west coast area of Taiwan. Their habitats overlap with the construction sites of the offshore wind farms[25]. Another species is the Black-faced spoonbill, a rare type of spoonbill that has been categorized as endangered species, migrates to Taiwan in Autumn and leaves around May next year,[26][27] and now is encountering the overlapping of its migration flyway with the offshore wind sites.[28]

The worry for the White Dolphin is that the piling noise during the wind farm's construction would affect the function of their immune system, with the risk of increasing its pressure. This will put the already endangered species at higher risk. In 2017, the Environmental Protection Administration required the developers to commit that within a range of 750 meters from the pile driving location, the underwater noise sound exposure level (SEL) shall not exceed 160 decibels [(dB) re. 1μPa^2s]. This is to mitigate temporary threshold shifts (TTS) in marine mammals and minimize any potential impact on their behavior.[29]. But in 2020, a cross-nation research team suggested from their experiment that setting the limit at SEL 138 decibels will be much safer for ensuring the dolphin's health condition. [29]

The environmental CSO, Taiwan Wild Bird Federation, demands the government follow the Equator Principles and the assessment mechanism from International Finance Corporation when selecting offshore wind sites.[30]. The challenge in identifying impacts on migrating birds is that Taiwan lacks a consistent database on birds' migration trajectory. There are at least 350 species that migrate through Taiwan Strait every year, and the current timelframe required by the environmental assessment is not feasible to conduct a comprehensive investigation on the migrating routes, heights, and numbers.[30]

Major Offshore Wind Projects

Operating Projects

Operating Project[12] Taiwanese Name(s) Capacity (MW)
Changfang And Xidao Offshore wind farm, Phase 1 彰芳一期風場(100MW), 彰芳二期, CIP彰芳暨西島離岸風場 600MW, 彰化西島離岸風力發電計畫, 彰芳一期, 彰芳離岸風場 100
Changfang And Xidao Offshore wind farm, Phase 2 彰芳二期(452MW), 彰芳二期, CIP彰芳暨西島離岸風場 600MW, 彰化西島離岸風力發電計畫, 彰芳一期, 彰芳離岸風場 452
Changfang And Xidao Offshore wind farm, Phase 3 西島風場(48MW), 彰芳二期, CIP彰芳暨西島離岸風場 600MW, 彰化西島離岸風力發電計畫, 彰芳一期, 彰芳離岸風場 48
Formosa 1 offshore wind farm 海洋竹南離岸式風力發電計畫, 海洋風場, 海洋竹南离岸式风力发电计画 128
Formosa 2 offshore wind farm 海能風場, 海能离岸风力发电计画, 海能離岸風力發電計畫 376
Greater Changhua Southeast wind farm 大彰化東南離岸風力發電計畫, 大彰化東南, 大彰化东南离岸发电量计画 605
Greater Changhua Southwest wind farm, Phase 1 大彰化西南第1階段離岸風場, 大彰化西南離岸風力發電計畫, 大彰化西南第一階段離岸風場, 大彰化西南第二階段, 大彰化西南离岸发电量计画 295
Hai Long Offshore wind farm, Phase 2A 海龍2號風場, 海龍三號離岸風力發電計劃圖, 海龙三号离岸风力发电计划图, 海龍二號離岸風力發電計畫, 海龙二号离岸风力发电计画, 海龍三號離岸風力發電計畫, 海龙三号离岸风力发电计画 300
Hai Long Offshore wind farm, Phase 2B 海龍2號風場, 海龍三號離岸風力發電計劃圖, 海龙三号离岸风力发电计划图, 海龍二號離岸風力發電計畫, 海龙二号离岸风力发电计画, 海龍三號離岸風力發電計畫, 海龙三号离岸风力发电计画 232
Taipower Offshore wind farm, Phase 1 彰化芳苑台電離岸風力發電場一期, 台電離岸一期, 離岸風力發電第一期計畫, 台電二期離岸風電計畫, 離岸風電二期計畫, 離岸發電第一期計畫, 台電離岸二期 109
Yunlin Offshore wind farm 天豐新能源雲林離岸風場, 雲林離岸風力發電廠興建計畫, 允能雲林離岸風場, 云林离岸风场 640
Zhong Neng wind farm, Phase 1 中能風場, 中能離岸風電計畫 300

Prospective offshore wind projects

Prospective Project[12] Taiwanese Name(s) Capacity (MW) Status
Formosa 3 offshore wind farm, Phase 3 海鼎一離岸式風力發電計畫, 海鼎三離岸式風力發電計畫, 海鼎二離岸式風力發電計畫 720 announced
Huanpeng wind farm, Phase 1 環澎一離岸風力發電計畫 360 announced
Huanpeng wind farm, Phase 3 環澎三離岸風力發電計畫 340 announced
Round 3.3 Auction of Offshore wind project 3-3期風場 (含取消開發權計900MW) 3,900 announced
Rui Li 1 Floating Offshore wind farm, Phase 1 瑞立一期浮式離岸風場 180 announced
Winds of September floating wind farm 九降風離岸風力發電計畫, 九降風離岸風電計畫 820 announced
Wo Neng Offshore wind farm, Phase 2 沃能一, 沃能二, 沃能一號離岸風力發電計畫, 沃能二號離岸風力發電計畫 600 announced
Xu Feng No. 1 Offshore wind farm 旭風一號離岸風力發電計畫, 旭風一 600 announced
Xu Feng No. 2 Offshore wind farm 旭風二號離岸風力發電計畫, 旭風二 750 announced
Xu Feng No. 3 Offshore wind farm 旭風三, 旭風三號離岸風力發電計畫 750 announced
Zhong Neng wind farm, Phase 2 中能風場, 中能離岸風電計畫 180 announced
Zhu Ting Offshore wind farm 竹廷 1,000 announced
Greater Changhua Northwest wind farm 大彰化西北離岸風力發電計畫, 大彰化西北离岸风力发电计画 583 construction
Greater Changhua Southwest wind farm, Phase 2 大彰化西南第2階段離岸風場, 大彰化西南離岸風力發電計畫, 大彰化西南第一階段離岸風場, 大彰化西南第二階段, 大彰化西南离岸发电量计画 337 construction
Hai Long Offshore wind farm, Phase 3 海龍3號風場, 海龍三號離岸風力發電計劃圖, 海龙三号离岸风力发电计划图, 海龍二號離岸風力發電計畫, 海龙二号离岸风力发电计画, 海龍三號離岸風力發電計畫, 海龙三号离岸风力发电计画 512 construction
Taipower Offshore wind farm, Phase 2 台電離岸一期, 離岸風力發電第一期計畫, 台電二期離岸風電計畫, 離岸風電二期計畫, 離岸發電第一期計畫, 台電離岸二期 295 construction
Chu Tin Offshore wind farm, Phase 1 新竹竹廷浮式風場, 竹廷浮動式離岸風電計畫, 100 MW浮動式示範風場 100 pre-construction
Datian Youde Offshore wind farm 彰化又德離岸風力發電廠興建計畫, 達天又德離岸風力發電計畫, 達天, 達天風場, 離岸風電3-2期, 彰化達天 700 pre-construction
Feng You Offshore wind farm 渢佑600MW, 渢佑離岸風場, 渢佑風場, 渢佑 600 pre-construction
Formosa 3 offshore wind farm, Phase 2 海鼎二風場600MW, 海鼎一離岸式風力發電計畫, 海鼎三離岸式風力發電計畫, 海鼎二離岸式風力發電計畫 600 pre-construction
Formosa 4 offshore wind farm, Phase 2 苗栗三(海盛)離岸風電, 海盛風電, 苗栗離岸風力發電計畫一, 苗栗三(海盛)風場, 海盛離岸風力發電場, 海豐 495 pre-construction
Formosa 5 offshore wind farm 海碩離岸風電, 苗栗離岸風力發電計畫二, 海碩風電, 苗栗二(海碩)離岸風場 1,536 pre-construction
Formosa 6 Haiguang Offshore wind farm 海廣離岸風力發電計畫 800 pre-construction
Huanyang Wei Lan Hai Changhua Offshore wind farm 蔚藍海彰化離岸風電計畫, 環洋離岸風力發電計畫, 蔚藍海彰化離岸風電計畫(440MW), 環洋專案, 環洋風場 440 pre-construction
Taichung Fengmiao Floating wind farm, Phase 1 渢妙 1 號; 3-1 期渢妙風場;渢妙風場500MW, 渢妙, 渢妙離岸風力發電計畫 500 pre-construction
Taichung Fengmiao Floating wind farm, Phase 2 渢妙二 (離岸風電3-2期);渢妙二600MW, 渢妙, 渢妙離岸風力發電計畫 600 pre-construction
Wei Lan Hai Miaoli Offshore wind farm 蔚藍海苗栗浮動式離岸風電計畫 1,360 pre-construction
Winds of September floating wind farm, Phase 1 九降風離岸風力發電計畫第一期, 九降風離岸風電計畫 180 pre-construction
Wo Neng Offshore wind farm, Phase 1 沃能一, 沃能二, 沃能一號離岸風力發電計畫, 沃能二號離岸風力發電計畫 2,400 pre-construction

Cancelled or shelved offshore wind projects

Cancelled Project[12] Taiwanese Name(s) Capacity (MW) Status
Bei Neng Offshore wind farm 北能離岸風力發電計畫, 北能風場通 1,204 cancelled
Chu Feng Offshore wind farm 竹风电力离岸风力发电计画, 新竹竹風風場, 竹風電力離岸風力發電計畫 448 shelved
Chu Tin Offshore wind farm, Phase 2 新竹竹廷浮式風場, 竹廷浮動式離岸風電計畫, 100 MW浮動式示範風場 600 cancelled
Chu Tin Offshore wind farm, Phase 3 新竹竹廷浮式風場, 竹廷浮動式離岸風電計畫, 100 MW浮動式示範風場 600 cancelled
Da Chungbu floating wind farm 大中部, 大中部離岸風力發電計畫, 大中部離岸風電 1,800 cancelled
EOLFI Offshore wind farm, Phase 1 500 cancelled
EOLFI Offshore wind farm, Phase 2 500 cancelled
EOLFI Offshore wind farm, Phase 3 500 cancelled
EOLFI Offshore wind farm, Phase 4 500 cancelled
EOLFI Offshore wind farm, Phase 5 500 cancelled
Feng Cheng Offshore wind farm 渢成, 新竹渢成750MW (浮式) 750 cancelled
Feng Fan Offshore wind farm 渢汎, 新竹渢汎 750 cancelled
Feng Li Offshore wind farm 苗栗渢利離岸風力發電計畫, 苗栗渢利1800MW(浮式), 渢利 1,800 cancelled
Formosa 3 offshore wind farm, Phase 1 海鼎一風場;科理歐永續能源海鼎一360MW(離岸風電3-2期), 海鼎一離岸式風力發電計畫, 海鼎三離岸式風力發電計畫, 海鼎二離岸式風力發電計畫 360 cancelled
Formosa 4 offshore wind farm, Phase 1 海盛風電, 苗栗離岸風力發電計畫一, 苗栗三(海盛)風場, 海盛離岸風力發電場, 海豐 1,360 cancelled
Fufang Offshore wind farm 福芳, 彰化福芳離岸風力發電計畫 600 cancelled
Fuhai Offshore wind farm 福海離岸風力發電計畫, 福海風場, 福海彰化離岸風力發電 120 shelved - inferred 2 y
Greater Changhua Northeast wind farm 沃旭能源大彰化東北風場, 大彰化東北離岸風力發電計畫, 大彰化東北 570 cancelled
Guanyin Offshore wind farm 桃園離岸風力發電廠興建計畫 350 cancelled
Guo Feng Offshore wind farm 果豐離岸風力發電計畫, 果豐離岸風電, 果豐離岸風場 375 cancelled
Haian Offshore wind farm 海安 2,500 cancelled
Haixia Offshore wind farm 力麗及天豐新能源的海峽一(300MW), 海峽28號, 海峽離岸風力發電 300 cancelled
He Er North Floating wind farm 禾爾北 2,400 cancelled
He Er South Floating wind farm 禾爾南 2,400 cancelled
He Yi Offshore wind farm 合儀 2,600 cancelled
Huan Ya Floating wind farm 環亞風場, 環亞浮式風場, 環亞離岸風場 1,200 cancelled
Huanyu Offshore wind farm 環宇離岸風力發電計畫, 環宇風場, 環宇 460 cancelled
Jia Neng Offshore wind farm 加能風場開發計畫, 加能 600 cancelled
Ju Dao Offshore wind farm 菊島, 菊島離岸風電 2,400 cancelled
Laizhong Offshore wind farm 萊中 600 cancelled
Lei Feng Offshore wind farm 萊風離岸風力發電計畫 950 shelved
Mei Sen wind farm 德能英華威德帥 240 MW離岸風場;德能美森240MW, 美森離岸風力發電廠興建計畫, 美森離岸風力發電 240 cancelled
New Taipei Offshore wind farm 新北離岸風力發電計畫 256 cancelled
Tai-Hai Taoyuan W1N Offshore wind farm 歐風台海桃園 W1N, 臺海桃園(W1N)離岸風力發電計畫 500 cancelled
Taichung Offshore wind farm 台中離岸風力發電廠興建計畫, 京宣 1,100 cancelled
Tao Hsin Offshore wind farm 桃新離岸風力發電廠興建計畫 152 cancelled
Xinfeng Offshore wind farm 新風離岸風力發電計畫 900 shelved
Zhangfeng Offshore wind farm 彰風, 彰風離岸風力發電計畫 900 shelved
Zhong Mei Offshore wind farm 鍾美離岸風力發電廠興建計畫 3,000 cancelled
Zhong Qian (InfraVest) Offshore wind farm 鍾虔, 鍾虔離岸風力發電廠興建計畫 580 cancelled

Past Offshore Wind Auctions and Programs

Phase 2: Potential Zones Projects

Several projects in phase 2 were or still are facing delays, such as Taipower Offshore Wind Power Project,[31] Greater Changhua Southeast wind farm,[32] Greater Changhua Southwest wind farm, and Yunlin Offshore wind farm. The reasons for these delays stem from various factors including the impact of COVID-19 on the global offshore wind construction capacity,[32], shortage of vessels globally[33], and welder shortage resulting from the growing construction industry in Taiwan in 2023.[31]

In July 2023, Changhua Xidao Offshore wind farm was reported to be the first offshore wind project in Taiwan that is ahead of its construction timeline.[34]

Phase 3: Zonal Development

Phase 3.1[35] On December 30th, 2022, the Taiwanese government finished the 1st round of the Phase 3 process(Phase 3.1 離岸風電第三階段區塊開發第1期) for awarding development capacity of a total of 3GW to the following projects. All projects are expected to start operating in 2027.[36][37][35]

At the end of August 2023, 5 projects reached financial close with a total capacity of around 2.3GW, making the capacity 665MW lower than the initial capacity awarded by the government. This is because 2 developers withdrew from the Phase 3.1 process due to project scale and financial concerns.[38]

Phase 3.2

The auctioned capacity in Phase 3.2 is set at 3.6GW (3GW from Phase 3.2 and 0.6GW from the remaining capacity of Phase 3.1)[39]. The government has introduced different rankings to prioritize projects, with top-ranking projects eligible for up to 900MW. Additionally, if developers sign corporate power purchase agreements (CPPAs) with two local companies, each with a minimum capacity of 100MW, they can receive an additional 100MW reward.[40]

In this new phase, several guidelines have been revised to align with the global offshore wind industry and provide more flexibility for developers. The government replaced the "key development items" in Phase 3.1 with a new "selecting score system" in Phase 3.2, involving 24 development items. Developers can now choose the items they can fulfill, and each item is assigned a score.[40][41] From the guideline document, the tender price is NTD 0 /kWh for the lower bound and NTD 2.49/kWh for the upper bound.[40]

Fossil Fuel in Taiwan

Fossil Fuel Resources and Retirement

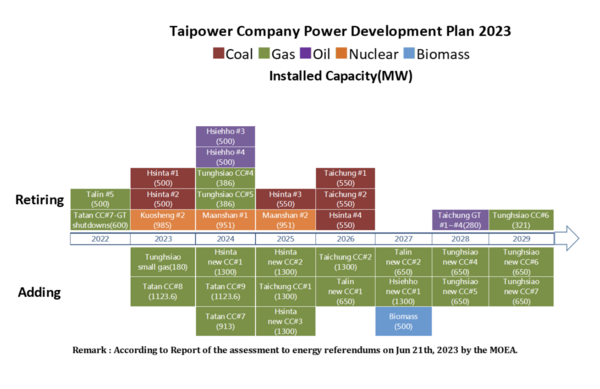

Taipower Company Power Development Plan 2023

Currently, there is no active coal mine in Taiwan. In 2018, the government stopped the final coal-fired project, the expansion of the Shen'ao power station due to disagreement from the public[42]. The Shen'ao power station expansion was also the last new coal-fired project ever proposed in Taiwan.[43]. Several coal and oil power plants, including four units of Hsinta power station, two caol units and four oil units of Taichung power station, and two units from Hsieh-Ho power station, will be conversed to gas power plants gradually.[44]

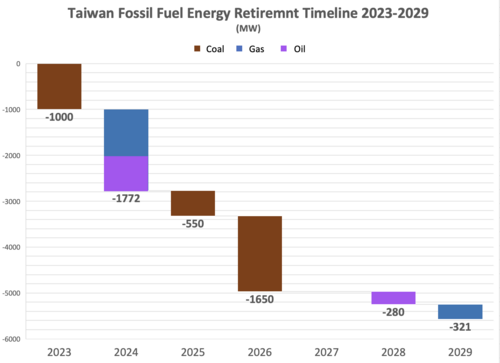

By 2026,5.3 GW of coal-fired capacity has retired in Taiwan.[45]

From the Taipower Development Plan updated in June 2023, the retirement plans for the coal power plants in Taiwan are[44]:

Data source: Taipower Company Development Plan 2023. Graph produced by GEM
Energy Source Retirement Plan[44] Development Plan[44]
Coal Power Plants
Gas Power Plant
Oil Power Plant

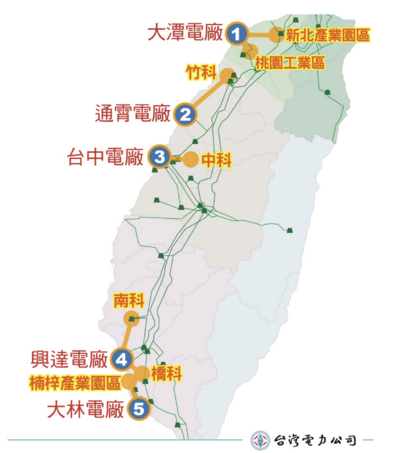

In Taichung, the Taichung power station is the fourth-largest coal-fired power plant in the world, with a total capacity of 5,500 MW. What's more, it was the coal-fired power plant with the highest annual CO2 emission in the world. Another 1,800 MW is generated by the Miaoli power station. [45][46][47] In recent years, due to the protest of local citizens, the annual coal consumption of the Taichung power station has been reduced from 21 million metric tons per year to 12.56 million metric tons, approximately a 50% reduction. The further plan will be to convert it into gas-fired power plants.[48] As for Mailiao power station, it's two generators will be retired in 2024 and 2025, respectively. The power plant will also be converted into gas-fired power plant.[49]

Overview of current fossil fuel impacts

In Taiwan, around 66% of the air pollution comes from domestic sources. Among that, the fossil fuel energy sector produces around 4.5% to 9.9%.[50] Due to the geological conditions and the locations of the coal-fired power plants, central and southern Taiwan suffer the most.[51] The pollution was specifically severe in Taichung, where the once largest coal-fired power plant Taichung power station is located. Over the past decade, there were rallies and large protests against the operation of the plant and to raise awareness of the harmful impact on health. In recent years, with the reduction of coal consumption of Taichung power station, the air quality is gradually improved but has not met the public's standard.[52]

Employment

Current employment by sector

From the Ministry of Labor, by July 2022, there were 2,243 workers working in the oil and natural gas sector[53]. From the Taiwan Power Company, the workers in the fossil fuel and hydropower sector 7,208.[54] There are several private-owned coal-fired power plants are not included into this number. The ballpark figure of the workforce in the fossil fuel sector in Taiwan is around 9,451.

Prospective employment from offshore wind sector

  • By 2025, the job created by offshore wind-related works will be 19,800[4]
  • By 2035, the job created by offshore wind-related works will be 74,000[3]

Land availability

Wind Integrated Information Platform, Geological Information System, twtpo.org

The map shows the phase 3: Zonal development area in Taiwan[55]

The space inventory included sea and land areas. The former contains developing offshore wind into deeper sea areas and beyond the territorial sea, further developing areas that may overlap with the fishing area, military or navigation waterways. The Bureau of Energy and Ministry of Economics will coordinate with various central departments on existing and proposing ports for infrastructure demand and identify communal corridors for cable lines and transmission space.[4]

Civil Society Engagement

  • Taiwan Ocean and Environmental Sustainability Law Center 漁民權益暨環境永續中心 [56]
  • Wild at Heart Legal Defense Association, Taiwan 台灣蠻野心足生態協會[57]
  • Taiwan SOUSA 台灣媽祖魚保育聯盟[58]
  • Changhua Environmental Protection Union 彰化縣環境保護聯盟[59]
  • Taiwan Wild Bird Federation 中華民國野鳥學會[60]

Symbolic Importance

  1. 98% of the energy sources in Taiwan replied from foreign countries. Around 95% of the imported sources are fossil fuels. Lacking self-produced energy is a national energy security issue, and the sources are also causing harmful impacts on the environment and public health. Developing renewable energy is critical to quit the reliance on other countries and accomplish a self-production, self-consumption system with carbon-zero sources.
  2. Taiwan Strait is the area with one of the highest potential for offshore wind in the world. In 2014, the 4C Offshore Wind published the wind speed ranking. Taiwan took 16 out of the top 20 potential sites in the world.[61] In 2023, Taiwan takes 8 sites in the top 20 list, and 13 out of the top 30 list.[62].

Governmental information

Related government papers

Taiwan has included the "2050 Net-zero Target" in the Climate Change Bill in 2022, which is the 18th country in the world that put the long-term net-zero goal into law.[63][64] There are several government plans and policies including the offshore wind target:

  • Nuclear-free homeland policy
  • Phased Goals and Actions Toward Net-Zero Transition 淨零轉型之階段目標及關鍵戰略[65]

Relevant political coalitions

Main authority: Ministry of Economic Affairs of Taiwan(MOEA, Taiwan)[4]

  • Policy: Ministry of Economic Affairs, State-owned enterprise, National Science and Technology Council, Ministry of National Defense, Ministry of Transportation and Communications, Ministry of the Interior, Ocean Affairs Council, Council of Agriculture, Executive Yuan.
  • Industrial Development: Ministry of Economic Affairs of Taiwan
  • Technology: National Science and Technology Council, Ministry of Economic Affairs of Taiwan
  • Talent cultivation: Ministry of Transportation and Communications, Ministry of Economic Affairs of Taiwan

Permitting

Nested within the developmental stages described on this page, Taiwan's offshore wind projects must undergo six primary permitting steps:[66]

  1. Approvals and consents, as required by local governments and the Taiwan Power Company.
  2. Establishment permit, which is granted after the successful completion and review of an environmental impact assessment.
  3. Recordation approval, which is granted by the Ministry of Economic Affairs.
  4. Power Purchase Agreement signed with Taiwan Power Company.
  5. Construction permit, which is granted by the Bureau of Energy and allows construction to begin.
  6. Electricity Enterprise License, which must be finalized before power can actually be sold to Taiwan Power Company.

Supply Chain

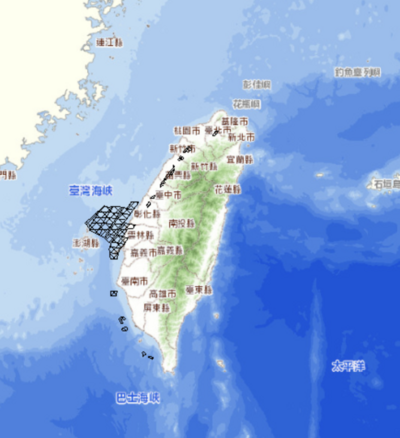

  • Port for wind turbine assembly at Taichung Port(台中港): The first port and seabed infrastructure was finished in March 2019 and was able to assemble a total capacity of 125MW annually. In 2020, the assemble capacity every year was raised to 375MW, and starting in 2020 further raised to 480MW every year.[8]
  • Port for foundation storage at Xingda Port and Taipei Port((興達港、臺北港): Annual production capacity of Xingda Port and Taipei Port can reach 180-300MW and 180-250MW, respectively. A Maritime Technology Innovation Center will also be established at Xingda Port for related technique training.[8][4]
  • Operate & maintenance Port at Changhua O&M Port(彰化漁港運維基地): Aimed to finish in 2021.[8] In May 2022, another port in the same city, CFXD & ZN offshore windfarm O&M base(彰芳暨西島及中能離岸風場運維基地) was finished. It was invested by Copenhagen Infrastructure Partners, CIP in the effort to localize the supply chain and technologies of offshore wind equipment in Taiwan.[67]
  • Vessels and construction: There are 16 types of marine vessels for offshore wind farm construction for inspection, anchoring, piling, and Crew Transfer Vessels(CTV). Taiwan currently lacks Jack up barge/vessel that can work under the water surface for 60 meters with a 1000T crane. The plan is to produce the Jack-up vessel domestically in 2021.[8][4]. In 2022, the Green Jade, the first floating DP3(Dynamic Positioning) heavy lift and installation vessel was built in Taiwan. According to the report: "the 216.5-meter DP3 vessel will feature a 4,000-tonne capacity Huisman crane and will be able to accommodate up to 160 people. The vessel will have a large deck space to enable transport and installation of multiple massive next-generation foundations and wind turbines in a single shipment"[68]
  • Digital Technology: Remotely Operated Vehicle (ROV) using Autonomous Remote Offshore Wind Inspection, Navigation and Deployment (AROWIND). Develop an integrated information platform to enhance operating efficiency.[4]

In 2020, the Energy of Bureau, Ministry of Economics announced the goal of establishing the supply chain of offshore wind in Taiwan. The action plan includes establishing assembly capacity, marine operations for installation and maintenance, developing floating offshore wind technology, conducting GWO Training, and developing local techniques to support digital operation.[4]

Siemens Gamesa Renewable Energy(SRGE) created an offshore wind nacelle industrial hub in Taiwan, supporting several ongoing offshore wind projects[69] Vestas extended its partnership with WPD AG in Taiwan, produce wind blades for the offshore wind projects.[70] [71]

In July 2024, the European Union initiated World Trade Organization dispute settlement proceedings concerning Taiwan's local content law. The localization law has a minimum content requirement of 60% locally made components, which EU officials allege is discriminatory against imports.[72] A delegation of Taiwanese officials traveled to the EU in September 2024 to discuss the dispute, as well as begin negotiations on localization of offshore wind components.[73]

Grid and Transmission

Current transmission resources

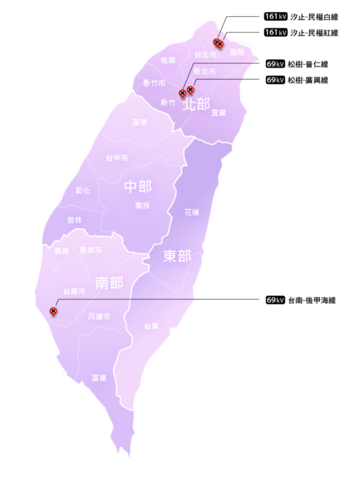

The transmission lines that are encountering bottlenecks are mostly located in northern Taiwan and one route in Tainan. These transmission lines require expanding transmission capacity. Currently, these locations are not overlapping with the offshore wind coast. The transmission use rate of the cities near the offshore wind farms is less than 50% and are safe for increased transmission capacity.[74]

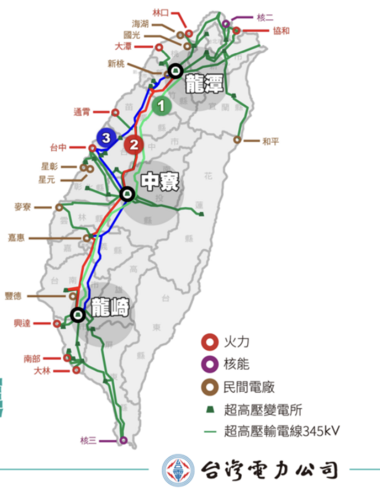

The bottleneck of transmission lines in Taiwan, Taiwan Power Company, June-21-2022
Grid and Transmission Map in Taiwan, Grid Resilience Enhancing Plan, Taiwan Power Company, Oct-4-2022,

New transmission needed for renewables

The Taipower predicted that the line capacity needs to increase 0.5GW annually since 2021 to meet the increasing offshore wind connecting to the grid.[75]

In order to support the offshore wind development on the west coast of Taiwan, the Taiwan Power Company will build seven stations with seven transmission lines which will support a capacity of 11GW connecting to the grid.[76]

Two new 345kV Lines in 2032 to support offshore wind capacity(No,2&3 from the map), Grid Resilience Enhancing Plan, Taiwan Power Company, Oct-4-2022

Two new transmission routes will be built to support the offshore wind and the gas-fired power capacity in 2032: 345kV Tongxiao(New)-North Miaoli-Baoshan Line (345kV 通宵(新)-北苗-寶山線)to transmit 3GW to Hsinchu Technology Park Hub and 345kV Gangfeng-Central Taiwan Science Park-New Central Taiwan Science Park Extra-High Voltage(345kV 港風-中科線及新建中科(新)超高壓) to transmit 3GW to Central Taiwan Science Park.[76]

Social and environmental impacts of new transmission

The Taiwan Power Company announced seven corridors for the developers to connect the submarine cable on the land. However, the developers are responsible for coordinating the environmental and social impacts. The potential impacts of the transmission construction include passing through sensitive areas such as the protected forest areas, fishing zones, aquaculture conservation and reproduction areas, artificial fish reefs, fishing prohibition zones for protected reefs, fishing port facilities, and the Dadu River(大肚溪) Wildlife Sanctuary.[77]

When the Environmental Protection Administration held a meeting to explain the transmission construction project of offshore wind with local residents in Xienxi County, Changhua City, the township office asked for a contract of 50% rebates of the generation revenue.[75]

Grid Infrasturcture

At noon time on January 25th, 2023, the real-time penetration rate of solar and wind reached 31.31%, equal to 6.23GWh.[78]

The Executive Yuan published the Smart Grid Integrated plan. The goal is to support 20% of VRE penetration rate in the grid in 2025, and enhance the grid resilience in the long-term[79]

In 2022, the Taiwan Power Company announced to start of a 10-year Grid Resilience Enhancing Plan with a total investment of NTD$5,645 billion (around 18.4 billion US dollars)[80] The 10-year plan is divided into three phases:[76]

  • Short-term Phase: NTD$ 87.1 billion by 2024
  • Mid-term Phase: NTD$ 170 billion by 2027
  • Long-term Phase: NTD$ 307.4 billion by 2032

Ownership

Major owners of current fossil capacity

Top Three Owner Companies of the Operating Coal Power Plants in Taiwan[45]

Owner Company Capacity in Total
Taiwan Power Co 9,500 MW
Formosa Petrochemical Corp 2,804MW
Ho-Ping Power Co 1,320MW

Top Three Owner Companies of both Operating & Planned & Construction Gas Power Plants in Taiwan [11]

Owner Company Capacity in Total
Taiwan Power Co 33,517MW
Chiahui Power Co 3,774MW
Mai-Liao Power Corp [100%] 2,400MW

Major owners of Offshore Wind

Top Five Owner Companies of Announced, Pre-Construction, Construction Offshore Wind Projects[12]

Total prospective offshore wind capacity: 22,237.5 MW
Owner Company Total Owned Capacity Share of total prospective capacity
Ørsted A/S, including Ørsted Taiwan Ltd 6,020 MW 27.1%
Synera Renewable Energy Co Ltd 2,336 MW 10.5%
Copenhagen Infrastructure Partners 1,700 MW 7.6%
EDF Renewables 1,360 MW 6.1%
Bluefloat Energy // Fortin Green Energy 1,000 MW apiece 4.5%

Owner Companies and Coalitions of Operating Offshore Wind Projects[12] Ownership coalitions may own different shares across projects. This is not reflected in the table below.

Total operating offshore wind capacity: 3,585.2 MW
Owner Company Total Owned Capacity Share of total operational capacity
Skyborn Renewables; TotalEnergies Group; Electricity Generating PCL; other unknown investors 640 17.9%
Cathay Capital Private Equity SAS; Ørsted A/S; Caisse de dépôt et placement du Québec 605 16.9%
Mitsui & Co Ltd; Yushan Energy; Northland Power Inc 532 14.8%
Copenhagen Infrastructure Partners P/S; Taiwan Life Insurance Co Ltd; TransGlobe Life Inc 500 13.8%
Synera Renewable Energy Co Ltd; JERA Co Inc; J&V Energy Technology Co Ltd 376 10.5%

In 2020. Orsted signed a corporate power purchase agreement (CPPA) with TSMC(Taiwan Semiconductor Manufacturing Co., Ltd) for 20 years, selling the total 920MW generated capacity from Greater Changhua Southwest wind farm and Greater Changhua Northwest wind farm to TSMC. This contract broke the record and was the biggest corporate renewables purchase contract at that time.[81][82]

Finance

Budget already allocated by the government: NTD$21.96 billion in total(around $716 million US dollars). Details listed as below:[4]

  • Bureau of Energy, Ministry of Economic Affairs: NTD$1.6 billion
  • Department of Industrial Technology (DoIT) of the Ministry of Economic Affairs: NTD$340 million
  • Industrial Development Bureau, Ministry of Economic Affairs: NTD$260 million
  • Bureau of Standards, Metrology, and Inspection, Ministry of Economic Affairs: NTD$220 million
  • Central Geological Survey, Ministry of Economic Affairs: NTD$240 million
  • Taiwan Power Company: NTD$19.276 billion

Expected to reach NTD 3.2 Trillion (€99.2 Billion) from foreign and domestic investment[3]

31 international and local banks participate in the funding project for offshore wind developers.[83]. The banks offer finance to offshore wind are listed on the official website Wind Power Financing Promotion

In 2020, the central government of Taiwan passed the National Development Council National Financing Guarantee Mechanism 國家融資保證機制,[84] The National Development Fund contributed NTD$6 billion, while eight state-owned banks collectively contributed NTD$62 billion, resulting in a guaranteed capacity of NTD$80 billion, calculated at 10 times the contribution amount(around US$ 2.6 billion). The target for the parent fund is to reach NTD$10 billion NT dollars, with a guaranteed capacity of NTD$100 billion(around US$ 32.5 billion. In the near future, there will be further efforts to persuade other private banks to participate and join. The Export-Import Bank of the Republic of China is the underwriting Execution Unit[85]

In November 2023, the Department of Investment Review, Ministry of Economic Affairs in Taiwan reported that the total investment in offshore wind projects in Taiwan has increased by nearly NTD$60 billion (approximately US$2 billion) thus far. The breakdown includes:[86]

Facing a financial crisis, the Yunlin Offshore wind farm secured new investments from various partners in August 2023.[86] Yunneng Wind Power Co., Ltd financially restructured the project with support from the Taiwanese Ministry of Economic Affairs and Energy Administration and more than two dozen domestic and international banks.[87]

Articles and resources

Related GEM.wiki articles

References

  1. ↑ “政府推動風電/光電政策執行情形,” Ministry of Economic Affairs, Retrieved May 15 2026
  2. ↑ “公正轉型優先推動戰略辧理情形,” 經濟部能源署, April 14 2024
  3. ↑ 3.0 3.1 3.2 3.3 3.4 3.5 3.6 The Development and Prospect of Offshore Wind Energy in Taiwan Yu Cheng-Wei, Director-General, Bureau of Energy, MOEA, Oct-2021
  4. ↑ 4.00 4.01 4.02 4.03 4.04 4.05 4.06 4.07 4.08 4.09 4.10 4.11 臺灣2050淨零轉型「風電/光電」關鍵戰略行動計畫 (核定本) National Council for Sustainable Development, April-2023
  5. ↑ 5.0 5.1 示範獎勵 風力發電單一服務窗口, Retrieved in June-17-2023
  6. ↑ 潛力場址 風力發電單一服務窗口: 工業技術研究院, Retrieved in June-17-2023
  7. ↑ 各潛力場址環境基本資料 風力發電單一服務窗口: 工業技術研究院, Retrieved in June-17-2023
  8. ↑ 8.0 8.1 8.2 8.3 8.4 8.5 離岸風電潛力場址推動策略 Ministry of Economic Affairs, Taiwan, Mar-27-2018
  9. ↑ 離岸風電建設再傳捷報 我國第3座離岸風場-海能風場 全數完工併聯 投入綠能發電行列 Ministry of Economic Affairs, Taiwan, March-25-2023
  10. ↑ 臺灣第二階段潛力場址首座完工風場 海能風電持續打造永續未來 FORMOSA 2, May-16-2023
  11. ↑ 11.0 11.1 Global Oil and Gas Plant Tracker Global Energy Monitor, January 2026 release.
  12. ↑ 12.0 12.1 12.2 12.3 12.4 12.5 12.6 Global Wind Power Tracker Global Energy Monitor, February 2026 release.
  13. ↑ Global Solar Power Tracker Global Energy Monitor, February 2026 release.
  14. ↑ Global Hydropower Tracker Global Energy Monitor, March 2026 release.
  15. ↑ 推動能源轉型「展綠、增氣、減煤、非核」 Ministry of Economic Affairs, ROC, Retrieved in June-15-2023
  16. ↑ 全國電力供需報告出爐 光電持續增加 2024年尖峰負載由日轉夜 Embracing the Low-carbon Age.ntu.edu.tw, May-19-2021
  17. ↑ 經濟部淨零關鍵戰略厚植產業綠色成長力 擘劃2030年電力配比願景 Ministry of Economic Affairs, MEA, Taiwan, Dec-28-2022
  18. ↑ 臺灣2050淨零排放 Executive Yuan, Taiwan, March-14-2023
  19. ↑ 離岸風電區塊開發規則終公布 釋出容量大增 2035年目標15GW Environmental Information Center, May-12-2021
  20. ↑ Offshore Wind Technical Potential in Taiwan Global Wind Energy Council & Ocean Renewable Energy Action Coalition, June 2021
  21. ↑ 風電搶漁場,達德能源竟派人帶刀威脅!台子村漁民怒吼「北有六輕加上電纜,未來還能去哪捕魚?」 News&Market Aug-13-2020
  22. ↑ 雲林離岸風力發電協調會 外聘人士介入-達德能源聲明如下 Wind.TAIWAN 離岸風電, Facebook, Aug-7-2020
  23. ↑ 【雲林離岸風場】重疊當地漁場衝突不斷 允能公司:盼主管機關確實執法 UP MEDIA - today Line, Aug-29-2020
  24. ↑ 爲什麽要保護中華白海豚?從棲息環境特徵談起 Taiwan Cetacean Society, 2016
  25. ↑ 「風機蓋在白海豚棲地」環團揚言訴願 環洋風場爭議聲中通過環評 Environmental Information Center, April-26-2023
  26. ↑ 黑面琵鷺保護區 Taiwan Heart of Asia, Retrieved in June-18-2023
  27. ↑ 2021黑面琵鷺全球同步普查結果 Taiwan Wild Bird Federation, 2021
  28. ↑ 白海豚、黑面琵鷺、飛安疑慮 台中「北能」離岸風場補件再審 Environmental Information Center, Mar-16-2022
  29. ↑ 29.0 29.1 為白海豚減噪 學者模擬風機真實打樁噪音 證實可能傷及海豚免疫力 Environmental Information Center, July-16-2020
  30. ↑ 30.0 30.1 海上鳥類研究繳白卷,風場如何防鳥擊?鳥會:快補進度、把國外經驗帶進來 Business Today, April-12-2022
  31. ↑ 31.0 31.1 國際搶船國內搶焊工! 離岸風電二期「後年併網發電」有隱憂 liberty Times Net, Nov-25-2023
  32. ↑ 32.0 32.1 大彰化東南及西南第一階段風場 全面併網發電時間延至2023年 WindTaiwan, Aug-16-2022
  33. ↑ Ørsted’s US, Taiwan Offshore Wind Projects Hit by Vessel Shortages; Sunrise Wind Still Not Out of the Woods offshoreWindBiz, Nov-6-2023
  34. ↑ 全台唯一超前完工計畫!彰芳暨西島風場完成全數 62 座水下基礎安裝作業 UP Media, July-19-2023
  35. ↑ 35.0 35.1 離岸風電區塊開發第1期選商結果正式出爐 Ministry of Economics, Taiwan, Dec-14-2022
  36. ↑ 離岸風電區塊開發開標 CIP渢妙排序第一 UDN, Dec-14-2022
  37. ↑ 風電區塊開發三階1期簽約延至6月底 2期選商進度受影響? WindTaiwan, May-5-2023
  38. ↑ 離岸風電區塊開發首輪5風場簽約 蓋哪裡? 有哪些環境議題? Environmental Information Center,Sep-1-2023
  39. ↑ 離岸風電3-2期 選商草案9月底公布 CTEE, Aug-15-2023
  40. ↑ 40.0 40.1 40.2 經濟部公告區塊開發第2期選商機制,遴選優秀開發業者一起再向前行 Ministry of Economic Affairs, Taiwan, Nov-23-2023
  41. ↑ 經濟部公告區塊開發 3-2 選商機制 明年 4 月選商截止、5 月公告結果 WindTaiwan, Nov-24-2023
  42. ↑ 賴清德宣布停建深澳電廠 環團肯定疑政策不透明 PTS, Oct-12-2018
  43. ↑ 深澳是台灣最後一座燃煤電廠 CommonWealth Magazine, Mar-17-2018
  44. ↑ 44.0 44.1 44.2 44.3 Long-term Power Development Plan Taipower Company, July-19-2023
  45. ↑ 45.0 45.1 45.2 Global Coal Plant Tracker Global Energy Monitor, January 2026 release.
  46. ↑ 台灣CO2排放站上世界舞台 台中、麥寮電廠列名十大 Environmental Information Center, Nov-16-2007
  47. ↑ 對抗煤電空污 找回乾淨空氣 Homemakers United Foundation, Sep-6-2016
  48. ↑ 大減碳 台中電廠燃煤改燃氣 Commercial Times, April-14-2023
  49. ↑ 麥寮電廠三燃煤機組除役後 台塑規劃轉型為燃氣電廠 News PTS, Dec-22-2021
  50. ↑ 針對各項空污來源 行政院有完整計畫妥適解決 Executive Yuen, Nov-3-2018
  51. ↑ 臺灣空氣污染來源是什麼?與空污有關的 8 個嚴峻事實 Greenpeace Taiwan, April-14-2017
  52. ↑ 環團批改善空污成效不彰 台中市府:持續管制計畫、空品有改善 News PTS, Nov-14-2022
  53. ↑ 職類別薪資調查動態查詢 Ministry of Labor, July-2022
  54. ↑ 人力資源發展 Taiwan Power Company, June-13-2023
  55. ↑ Wind Integrated Information Platform Geological Information System, Retrieved in June 17 2023
  56. ↑ 漁民權益暨環境永續中心 Taiwan Ocean and Environmental Sustainability Law Center Facebook Official Page, Retrieved in June-18-2023
  57. ↑ 台灣蠻野心足生態協會 Retrieved in June 2023
  58. ↑ 台灣媽祖魚保育聯盟 Retrieved in June-18-2023
  59. ↑ 彰化縣環境保護聯盟 Retrieved in June-18-2023
  60. ↑ 中華民國野鳥學會 Retrieved in June-18-2023
  61. ↑ 今夏太陽能助攻!「離岸風電」可望達2025年目標? 經濟部、WPD達德能源這麼說 Fount Media, July-24-2020
  62. ↑ Global Offshore Wind Speeds Rankings 4C Offshore, Retrieved in June-18-2023
  63. ↑ 氣候變遷因應法」三讀通過:碳費開徵、溫室氣體管理基金、碳權交易所將上路 Wind Taiwan, Jan-10-2023
  64. ↑ “Net Zero Roadmap,” 2050 Net-Zero, Retrieved May 15 2026
  65. ↑ 淨零轉型之階段目標及關鍵戰略 National Development Council, Dec-28-2022
  66. ↑ “Global offshore wind: Taiwan,” Norton Rose Fulbright, October 15 2024
  67. ↑ 亞太首座離岸風電運維基地竣工 超越彰化漁港原因曝光 Liberty Time News, May-18-2022
  68. ↑ Green Jade Launches in Taiwan, Delivery Pushed to 2023 offshoreWind.biz, April-4-2022
  69. ↑ SGRE creates offshore wind nacelle industrial hub in Taiwan Power Technology, May-18-2020
  70. ↑ Vestas extends partnership with wpd with onshore order in Taiwan VESTAS, Nov-18-2022
  71. ↑ Vestas and Tien Li Roll Out First Offshore Wind Turbine Blade in Taiwan offshoreWind.Biz, April-25-2022
  72. ↑ “EU Disputes Taiwan’s Offshore Wind Local Content Regulations,” OffshoreWind.biz, July 29 2024
  73. ↑ “【風電國產化風暴1】國產化鬆綁左右為難 經濟部長的善意恐引發連串爭議,” Yahoo News, September 18 2024
  74. ↑ 電網供電資訊 Taiwan Power Company, June-21-2022
  75. ↑ 75.0 75.1 用「共榮」藥方 紓解輸配電抗爭 Taipower Journal, Aug-2017
  76. ↑ 76.0 76.1 76.2 強化電網韌性計畫 Taiwan Power Company, Oct-4-2022
  77. ↑ 海纜上岸走共同廊道 風場開發風險增 Commercial Times, April-8-2023
  78. ↑ 風+光首度破發電占比三成 每三度電約有一度是綠電 且電壓無虞 Ministry of Economic Affairs, Taiwan, Jan-25-2023
  79. ↑ 智慧電網總體規劃方案 核定本 Executive Yuan, Feb-2020
  80. ↑ 10年投5645億 台電啟動「強化電網韌性計畫」 Global Views Magazine, Nov-8-2022
  81. ↑ 沃旭大彰化西北、西南第二階段風場 可望今年達成最終投資決定 WindTaiwan, Feb-6-2023
  82. ↑ World’s Largest Renewable Energy Corporate Power Purchase Agreement Signed in Taiwan offshoreWindBiz, July-8-2020
  83. ↑ 風力發電融資推廣 風力發電單一服務窗口, Retrieved in June-18-2023
  84. ↑ 國家融資保證機制推動方案(核定本), National Development Council, June 2023
  85. ↑ 離岸風電國家融資申請 將大爆發 Commercial Times, Oct-4-2022
  86. ↑ 86.0 86.1 86.2 86.3 86.4 經濟部投資審議會第2次會議新聞稿 Department of Investment Review, Ministry of Economic Affairs, Taiwan, Nov-28-2023
  87. ↑ “Successful Completion of Financial Restructuring for 640 MW Yunlin Offshore Wind Farm Project in Taiwan,” Skyborn Renewables, January 1 2024
